The shipbuilding gap.

China builds more than half the world’s ships. Every time the lead in shipbuilding moved, it went to the country with the better production system.

World shipbuilding, 1890s to 2026Sources in English, Chinese and JapaneseAbout 7 minutes

China delivered about 1,400 ships in 2024

Those large merchant ships made up 57% of the world’s tonnage. The US delivered five, about 0.1%.

Large merchant ships delivered in 2024
China
about 1,400
United States
5

A leaked 2023 Office of Naval Intelligence slide put China’s shipyard capacity at 232 times America’s: about 23 million tons against under 100,000. The Navy called it estimates from public sources. It measures capacity, not ships delivered, and its method is not public.

Chinese yards build warships and cargo ships side by side

China’s state shipbuilder, CSSC, once delivered more than 250 ships in a single year. CSIS counts that as more commercial tonnage than the whole US industry has built since the end of World War II.

Satellite images of Jiangnan’s base on Changxing Island show Evergreen container ships moored beside Type 055 warships. China calls this military-civil fusion (军民融合, jūnmín rónghé). Commercial orders pay for the cranes, workers and steel that naval work also uses.

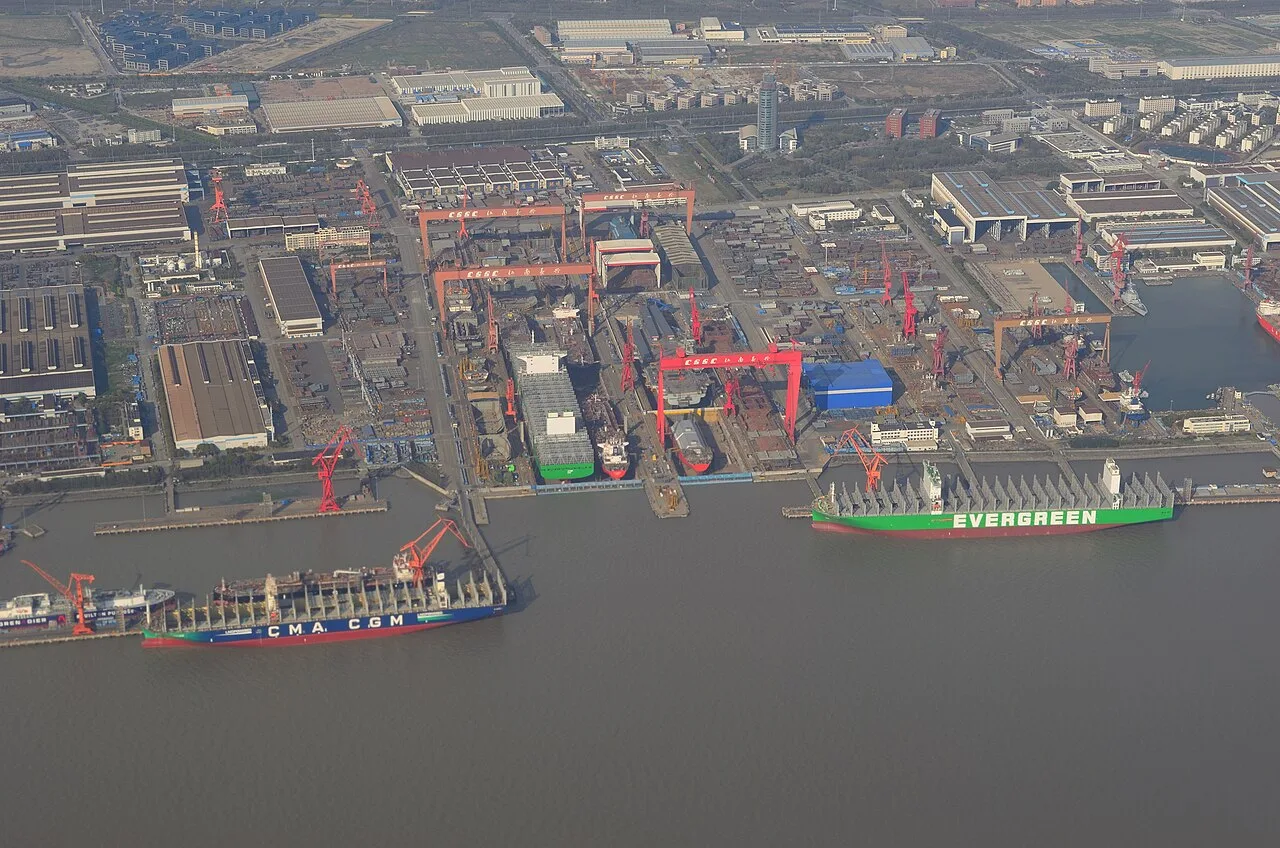

Aerial view of Jiangnan Shipyard with red gantry cranes and two large container ships at the quay
Jiangnan Shipyard on Changxing Island, Shanghai, 2022, with Evergreen and CMA CGM container ships at the quay. Photo: Raysonho, public domain (CC0).

The lead has moved three times

Britain led for about a century. Japan took the lead in 1956, Korea in 2000 and China in 2010. Each new leader built ships in a different way. Today China, Korea and Japan build about 95% of the world’s ships.

The world’s largest shipbuilder, and how it built
Britain, until 1956
Riveted hulls built by skilled trades.
Japan, 1956 to 2000
Welded hulls built in large blocks.
Korea, 2000 to 2010
Giant docks, built through the 1990s.
China, 2010 to today
State-funded capacity, then digital yards.

Britain kept riveting while others welded

In the 1890s Britain built about 75 to 80% of the world’s ships, two-thirds of them on the Clyde in Scotland.

Economic historian Edward Lorenz found the problem was the system, not the workers. Each craft union held rights over certain machines and materials, which protected its members from hire-and-fire cycles. Those rights made welding and prefabrication very hard to adopt. A riveter took about six months to train. A wartime welder took about two weeks.

Growth in ship output, 1947 to 1957
+300%
World
+18%
Britain

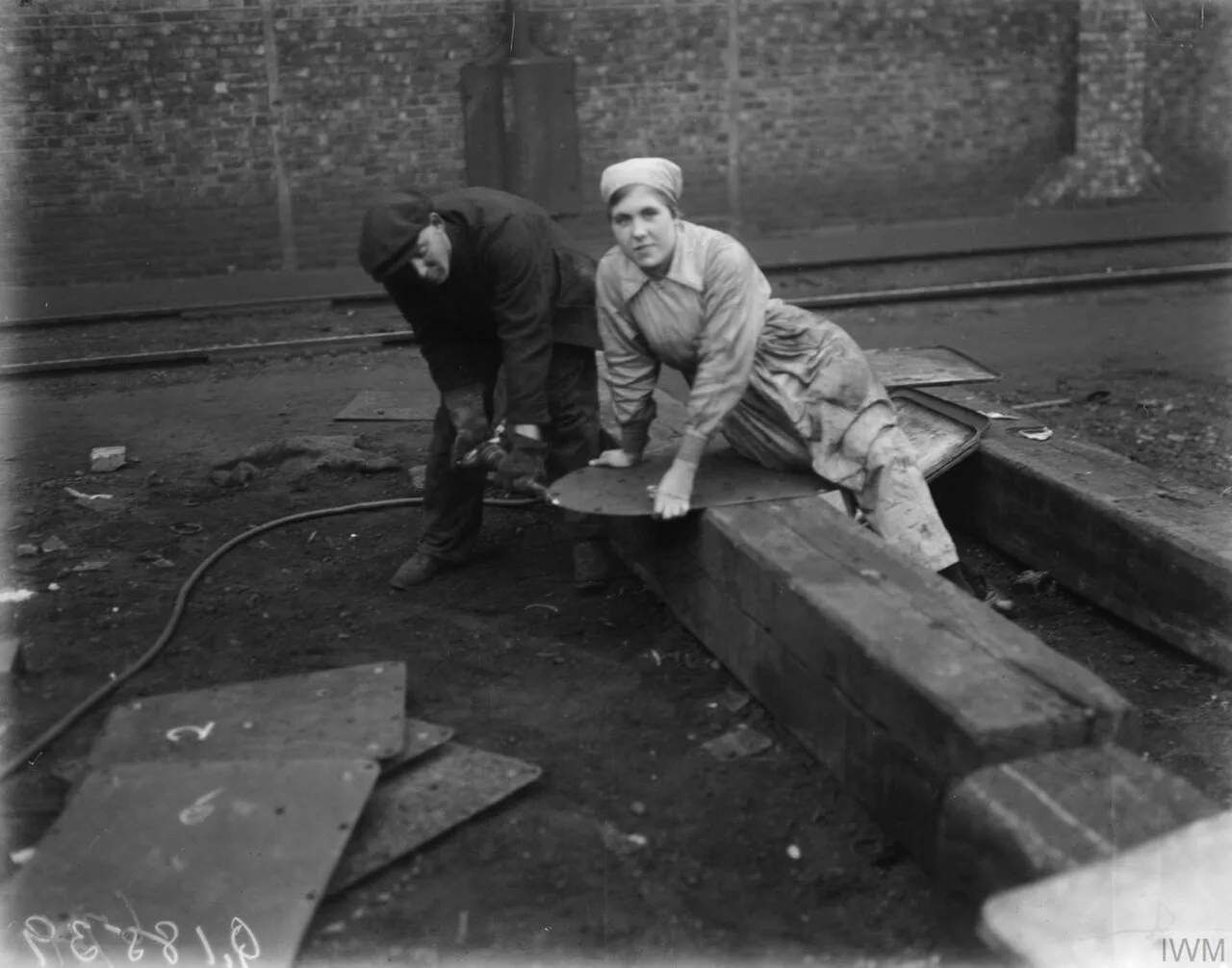

A man and a woman riveting a steel plate on a wooden block in a shipyard
Men and women riveting at a shipyard on the Clyde during the First World War. Photo: Royal Navy official photographer, Imperial War Museums (Q 18539), public domain.

The US once built a cargo ship in 42 days

From 1941 to 1945, 18 emergency yards built 2,710 Liberty ships, a standard cargo design. The ships were welded, not riveted, from about 250,000 prefabricated parts each.

Henry Kaiser’s yards hired people who had never seen a shipyard. Prefabrication and standard work made the jobs quick to learn. By mid-1944, 41% of the welders at his Richmond, California, yards were women.

Average days to build a Liberty ship
Early 1942
244 days
Late 1942
120 days
1943 average
42 days

The SS Robert E. Peary went from keel to launch in 4 days and 15 hours. It was a staged publicity event, with parts prepared in advance.

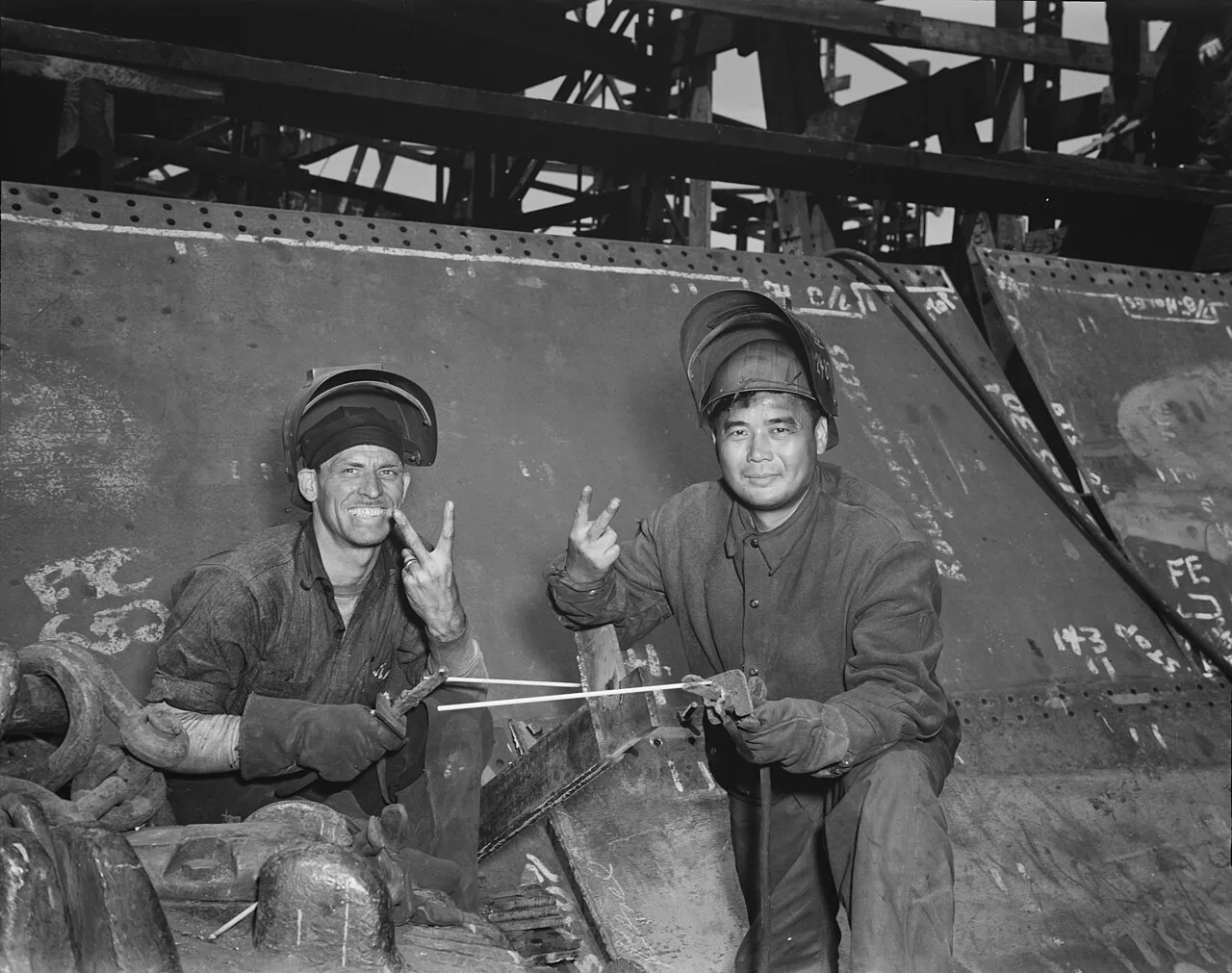

Two welders in protective hoods sitting against the steel hull of a ship under construction
Welders on the Liberty ship SS Frederick Douglass at the Bethlehem-Fairfield yard in Baltimore, May 1943. Photo: Roger Smith, Library of Congress, public domain.

The fast ships had hidden costs

Economist Peter Thompson went back to the yard records decades later. The yards had also roughly tripled their equipment. Counting that cuts the share of the speed-up credited to learning about in half. Some of the speed came at the cost of quality: at the worst yard, over 60% of ships had cracked hulls.

When production stopped, the yards forgot 3 to 5% of what they had learned each month. Flow and standard work without quality built in at the source led to repair work at sea.

What Thompson found
3×
Growth in equipment
Over 60%
Cracked hulls, worst yard
3–5%
Learning lost monthly

US commercial orders fell to zero in the 1980s

From 1936, the US paid its yards up to half the cost difference with foreign yards. In 1981 the Reagan administration ended that subsidy. Every rival country kept paying its own.

Wages do not explain the gap that followed. In 2010 US yard labor cost about $18 an hour, against about $16 in Korea. The difference is volume. A yard that builds two ships a year cannot learn as fast as one that builds twenty. A 2005 benchmark study found US yards built few ships in modules and fitted little equipment before assembly. It told them to “become more lean.”

US shipbuilding after 1981
69 → 0
Orders, 1980 to 1988
About 95%
Revenue from the Navy
4–5×
Price vs. world

Japan invented the modern method

Post-war Japan stopped building hulls piece by piece. Its yards welded large blocks, fitted pipes and wiring inside each block, then joined the blocks in the dock. Government-planned orders kept demand steady while the yards learned. By the mid-1960s Japan built about half the world’s ships.

Korea took the method to a larger scale. In the 1990s Korea built giant docks while Japan, after government-ordered capacity cuts in 1980 and 1988, held back. Japan now builds about 13% of the world’s ships.

China’s yards are now learning, not only growing

China paid for its rise. Economists Barwick, Kalouptsidi and Zahur measured about $91 billion in hidden subsidies from 2006 to 2013. 69% of it paid for new yards, many of them inefficient, and the returns were poor. Capacity is not capability.

Some Chinese yards now improve with each ship. Hudong-Zhonghua builds LNG carriers, a market Japan and Korea held five years ago. Chinese trade press credits digital shipbuilding (数字化造船, shùzìhuà zàochuán) and parallel production (并联式, bìngliánshì), where blocks are built at the same time instead of one after another.

Hudong-Zhonghua LNG carriers, build time
  1. Ship 276 days faster than ship 1.
  2. Ship 320 days faster again.
  3. Ship 434 days faster again.
  4. 2023A record build of 17 months and 8 days.
  5. Dec 2025A record build of 16 months. Korea’s usual time was 18 to 24 months.

A Korean company is rebuilding a yard in Philadelphia

In December 2024, Korea’s Hanwha bought Philly Shipyard from Norway’s Aker. The yard built most of the large US ships for domestic trade, at about 1.5 ships a year. In 2025 it announced an expansion with two new docks.

Philadelphia workers now train at Hanwha Ocean’s yard in Geoje, Korea, the first yard to deliver 200 LNG carriers. In August 2025 the yard won an order for 10 product tankers, the largest US commercial order in over 20 years. Lean readers know the pattern from NUMMI in 1984: a foreign production system brought into a struggling US plant, with its workers retrained in it.

Hanwha’s plan for Philly Shipyard
$100M
Purchase price
$5B
Planned expansion
1.5 → 20
Ships per year

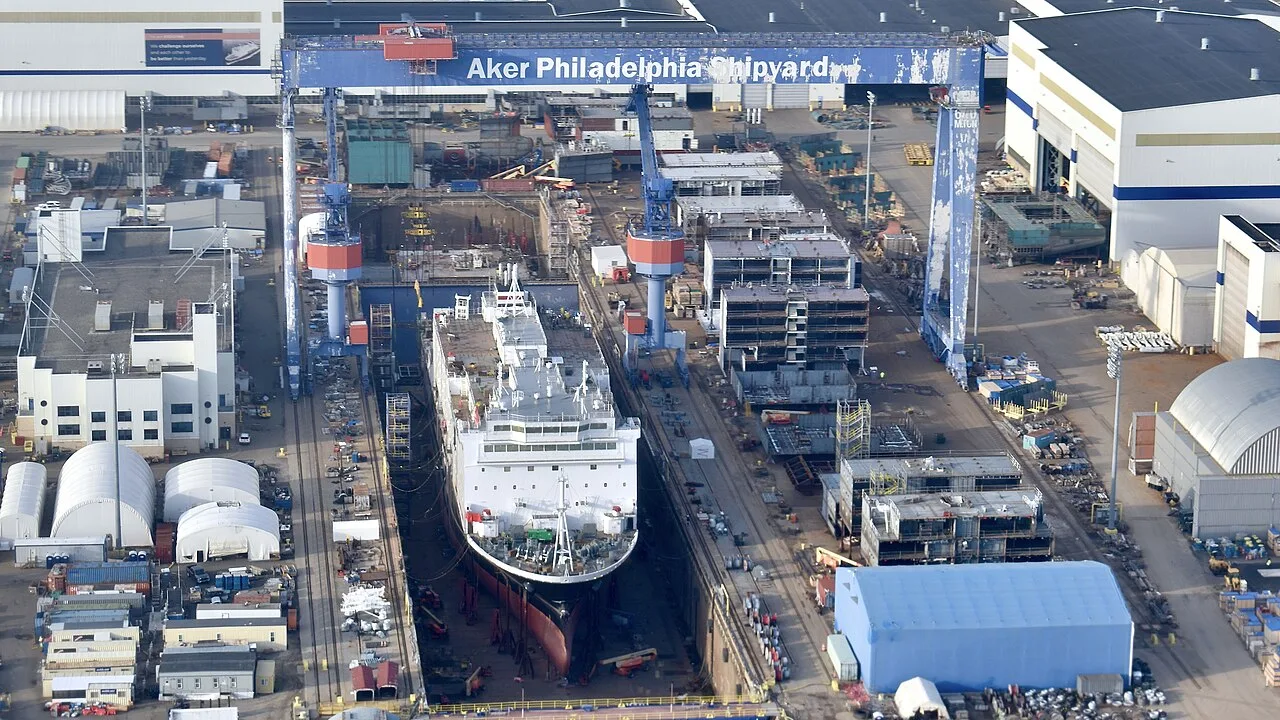

Aerial view of Philly Shipyard with a large white ship under construction in the dry dock
Philly Shipyard in February 2024, before Hanwha bought it. Photo: MastersHall, CC BY-SA 4.0.

US policy has not moved the numbers much

While US port fees loomed in 2025, China’s monthly share of new orders fell below 30%. Once shipowners adjusted, it rose back to 84%. Over the full year it fell from 70% to 63%.

US and Chinese policy, 2025 to 2026
  1. Apr 2025The SHIPS for America Act, for a 250-ship US fleet, returns to Congress. It is still in committee.
  2. Oct 2025US port fees on Chinese-built ships start. China answers with its own fees and sanctions on five US subsidiaries of Hanwha Ocean.
  3. Nov 2025The US suspends the fees until November 2026 as part of a trade truce.
  4. Feb 2026The Maritime Action Plan proposes a fee on all foreign-built ships.

The Navy’s own build times keep growing. Destroyers and submarines that took 5 to 6 years in the 2000s now take 9 to 10. Virginia-class submarines arrive at about 1.2 a year, against 2.0 funded.

The lesson

Each time the lead moved, it moved to a better production system: rivets to welds, welds to blocks, blocks to scale, scale to state-funded learning. Steady demand lets a yard learn, and a yard that stops building forgets. Philadelphia is now testing whether the method can come back to the US.

Frequently asked

Is China’s shipbuilding capacity really 232 times America’s?
The figure comes from a leaked 2023 US Office of Naval Intelligence slide: Chinese shipyard capacity of about 23.25 million tons against under 100,000 tons for the US. The Navy called the slide estimates and projections from public sources, and it measures capacity with an undisclosed method. The measured numbers are also stark. In 2024 China delivered about 1,400 large merchant ships, 57% of world tonnage. The US delivered 5, about 0.1%.
Why are US-built ships 4–5 times more expensive?
Wages are not the cause. In 2010 US shipyard labor cost about $18 an hour against about $16 in Korea, and labor is roughly $10M of a $200M ship. The cause is volume: a yard building 2 ships a year cannot learn or buy like one building 20. A 2005 First Marine International benchmark found US yards built few ships in modules and fitted little equipment before assembly. It recommended that US yards "become more lean."
What actually happened to American shipbuilding?
From 1936, US commercial shipbuilding relied on the Construction Differential Subsidy, which paid up to 50% of the cost gap with foreign yards. The Reagan administration ended it in 1981 while every rival kept subsidizing. Commercial ships on order at US yards fell from 69 in 1980 to zero in 1988. Today about 95% of US shipbuilding revenue comes from the Navy.
What were the Liberty ships, and what did they prove?
They were America’s Second World War emergency fleet: 2,710 standard cargo ships. Average build time fell from 244 days to 42 through welding, prefabrication and standard work. A welder trained in about 2 weeks, a riveter in about 6 months. Later archive work by Peter Thompson added two corrections: yard equipment tripled, which halves the estimated effect of learning, and over 60% of ships at the worst yard had hull fractures. Idle yards forgot 3–5% of their learning per month.
Is China’s dominance just subsidies?
Subsidies are large but not the whole story. Barwick, Kalouptsidi and Zahur (Review of Economic Studies, 2024) measured about $91B of hidden support from 2006 to 2013, with poor returns, since 69% went to new yards that were often inefficient. The evidence that China is now learning comes from Hudong-Zhonghua’s LNG carriers: each ship faster than the last, down to a 16-month record in December 2025 against Korea’s usual 18–24 months. Chinese sources credit digital shipbuilding and parallel (并联式, bìngliánshì) production.
What is happening at Philly Shipyard?
Korea’s Hanwha bought Philly Shipyard for $100M in December 2024, then announced a $5B expansion under Korea’s $150B MASGA package: two more docks and a target of up to 20 ships a year, against the yard’s past rate of about 1.5. Philadelphia workers train at Hanwha Ocean’s Geoje yard, the first to deliver 200 LNG carriers. In 2025 the yard booked 10 product tankers, the largest US commercial order in over 20 years. China responded by sanctioning five Hanwha Ocean US subsidiaries.
Did the US port fees on Chinese ships work?
Briefly. While the Section 301 fees loomed in 2025, China’s monthly share of world new orders fell below 30%. Owners adjusted and the share rose back to 84%. The fees took effect on October 14, 2025 and were suspended in November 2025 as part of the US–China trade truce. Over the full year, China’s order share fell from 70% to 63%, with Korea the main beneficiary.
