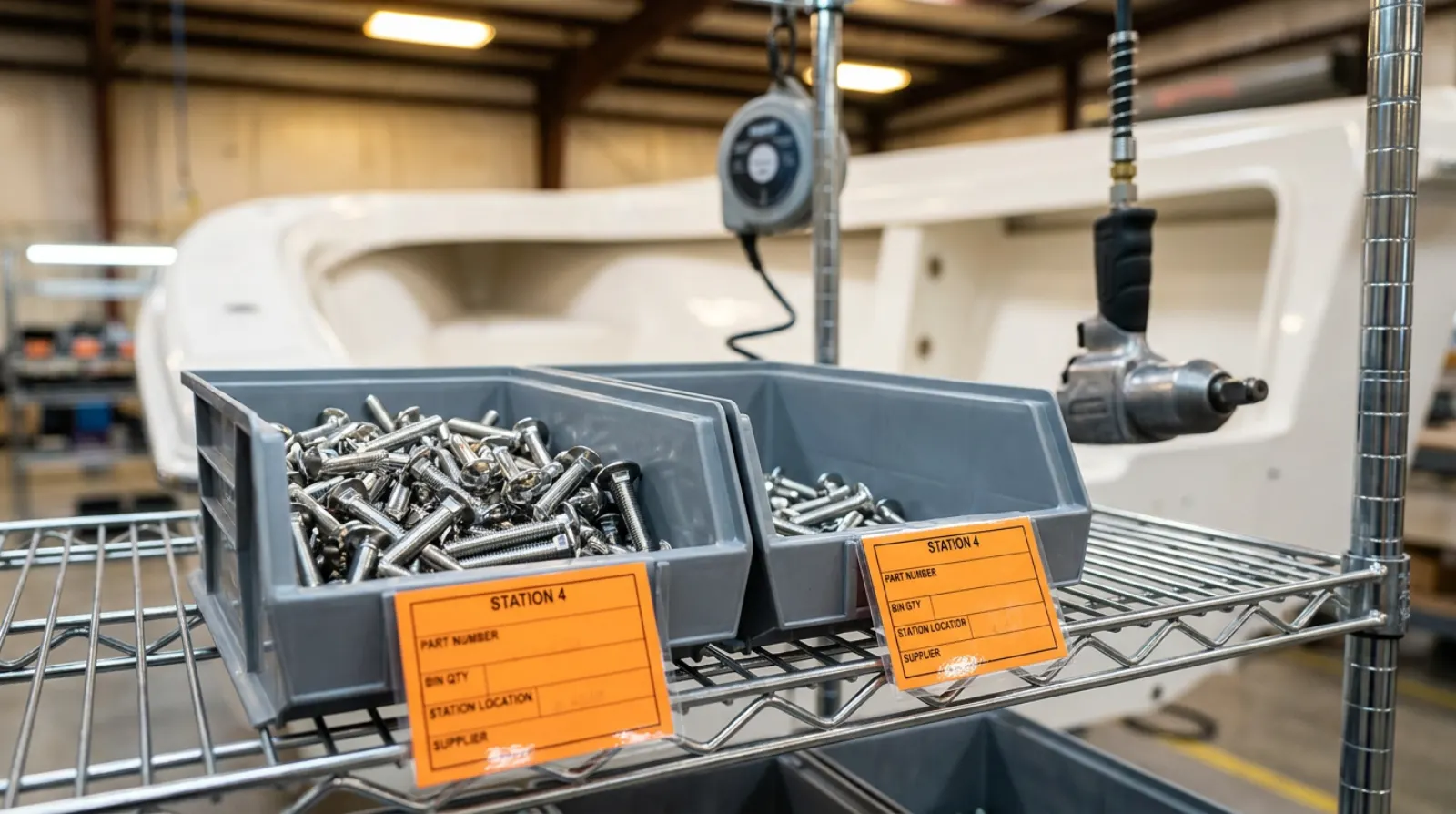

Shelf bins of stainless bolts, each with an orange kanban card
Field guide · Manufacturing

Kanban for high-mix, low-volume manufacturing

Kanban mechanics for operations where every build differs, replenishing the everyday parts rather than finished products across custom manufacturing floors.

Kanban functions as a physical pull signal where consumption triggers replenishment. Standard textbooks base examples on high-volume assembly lines with steady demand. Custom manufacturing brings different challenges because each order varies, usage per component stays small, and expensive specialty items carry long lead times. The solution begins with part segmentation: establish visual loops for standard parts shared across orders, and plan unique items separately.

Case · 10 lessons · 23 minutesJump to the full training course built for one builder

Why high-mix work complicates kanban loops

Most kanban manuals reflect automotive assembly plants with repeating schedules. Four operational realities change when every order across your shop floor requires custom work.

Low consumption rates

Daily consumption for each part stays low and irregular. An item needed on half your builds averages 0.5 each working day. The standard formula holds up, but the resulting numbers remain small.

Static assembly locations

Large machinery and equipment remain stationary during assembly while operators bring parts to the unit. When a single washer is missing, an operator walks away from the station to hunt for it.

Shifting product schedules

The mix of work changes from week to week. Containers calculated for an earlier schedule become outdated, creating sudden stockouts on active hardware alongside overstocked bins for slow jobs.

Costly custom materials

Certain specialty components, like custom panels or large drives, carry high costs and long supplier lead times. Storing these parts in point-of-use bins locks up operating cash and shop floor space.

An empty bin labeled vacuum sealant tape on a stockroom shelf

Sort parts before designing loops

Decide which parts warrant visual replenishment before placing containers

Separate common parts from custom orders

Failed lean initiatives often stem from attempts to put every inventory item into a bin system. Sort components at each workstation into Runners, Repeaters, and Strangers based on how frequently teams consume them and their unit costs. Runners are common, low-cost parts with short supplier lead times used on nearly every job. Repeaters appear on many builds with moderate expense, which makes them suitable for reorder points. Strangers are costly, unique parts tied to specific customer orders with extended lead times. Strangers stay on material requirements planning tied directly to job schedules, rather than visual floor replenishment.

ClassExamplesHow to replenish
Runnersfasteners, tape, cable ties, abrasives, gloves, adhesiveUse two-bin racks directly at the workstation for low-cost supplies consumed daily with local suppliers three days away.
Repeatersbearings, filters, hydraulic fittings, pumpsMaintain a reorder point that initiates supplier replenishment when on-hand inventory drops to a defined threshold.
Strangersmotors, castings, customer-specified panels, custom trimOrder directly through material requirements planning so components arrive when the specific production job begins.

Station counts show about 70 out of 100 components are Runners, 20 are Repeaters, and 10 are Strangers. Those 10 Strangers represent roughly 80 percent of inventory spending. Put visual bins on the common parts and schedule the rest.

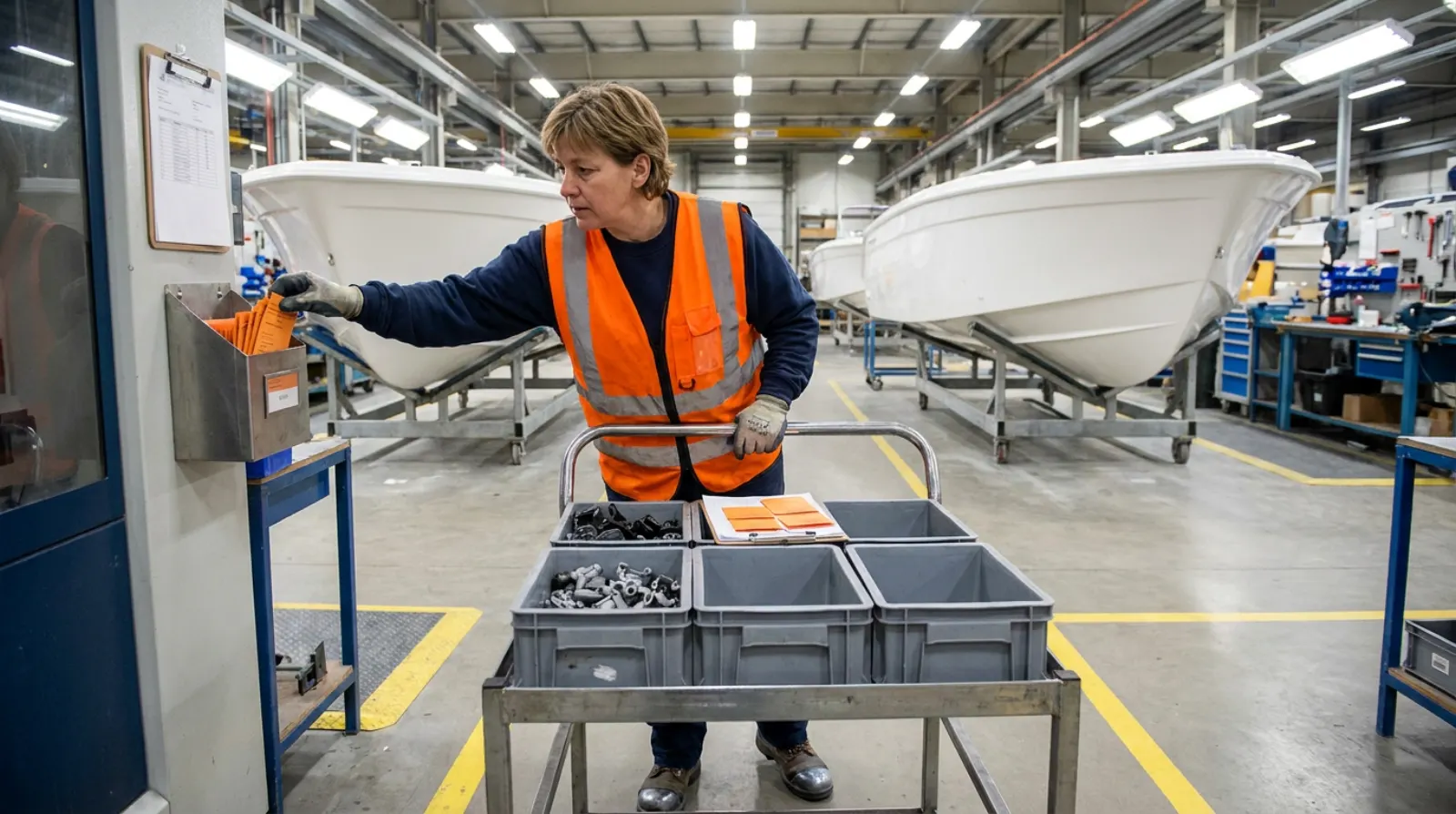

A material handler pushing a cart of full bins down an aisle

The physical card loop

A physical card, drop box, dedicated handler route, and returned container

How the visual cycle operates

Every physical card pairs with a specific container. The card stays attached to its container until empty, and containers never sit without cards. This direct pairing keeps the replenishment cycle accurate without digital tracking. A material handler walks a standardized route through the shop floor every 90 minutes. Technicians drop empty signals without placing calls, sending emails, or leaving work areas.

  1. 1Empty containerAn operator uses the final piece, pulls the attached card, drops it into the collection box, and pulls forward the second full bin.
  2. 2Route sweepThe material handler collects dropped cards along the scheduled walking path and checks workstations for raised replenishment flags.
  3. 3Stockroom retrievalThe handler pulls the specified hardware and quantity listed on the card, attaching the card to the freshly filled container.
  4. 4Return deliveryThe handler returns the replenished bin to the workstation rack on the subsequent loop, restoring the primary reserve.

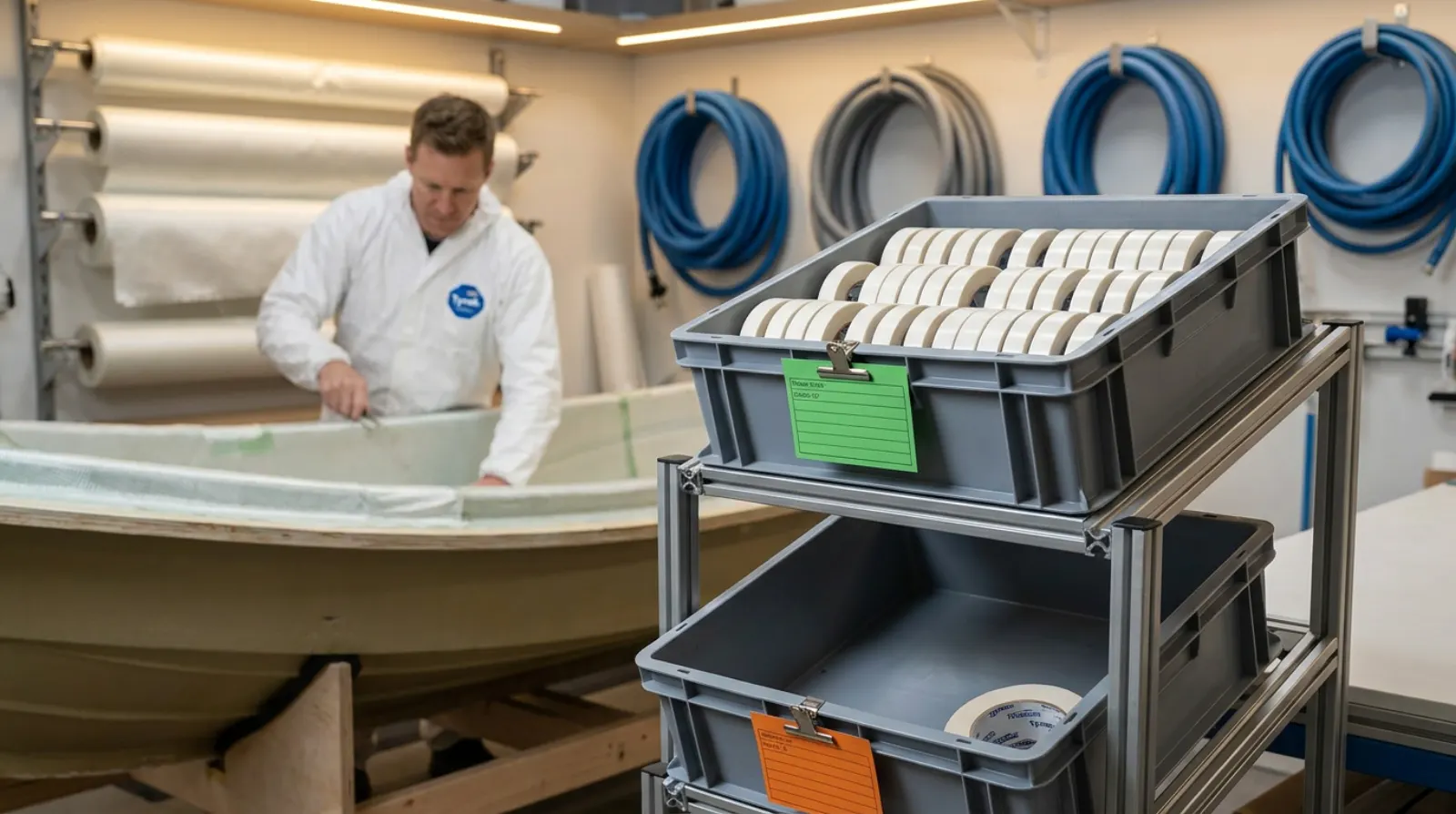

A two-bin gravity rack of tape rolls at a work station

Gravity-flow racks

Racks hold two containers per channel for Runners. When the front bin empties, the operator removes it, the reserve slides forward, and assembly work continues uninterrupted.

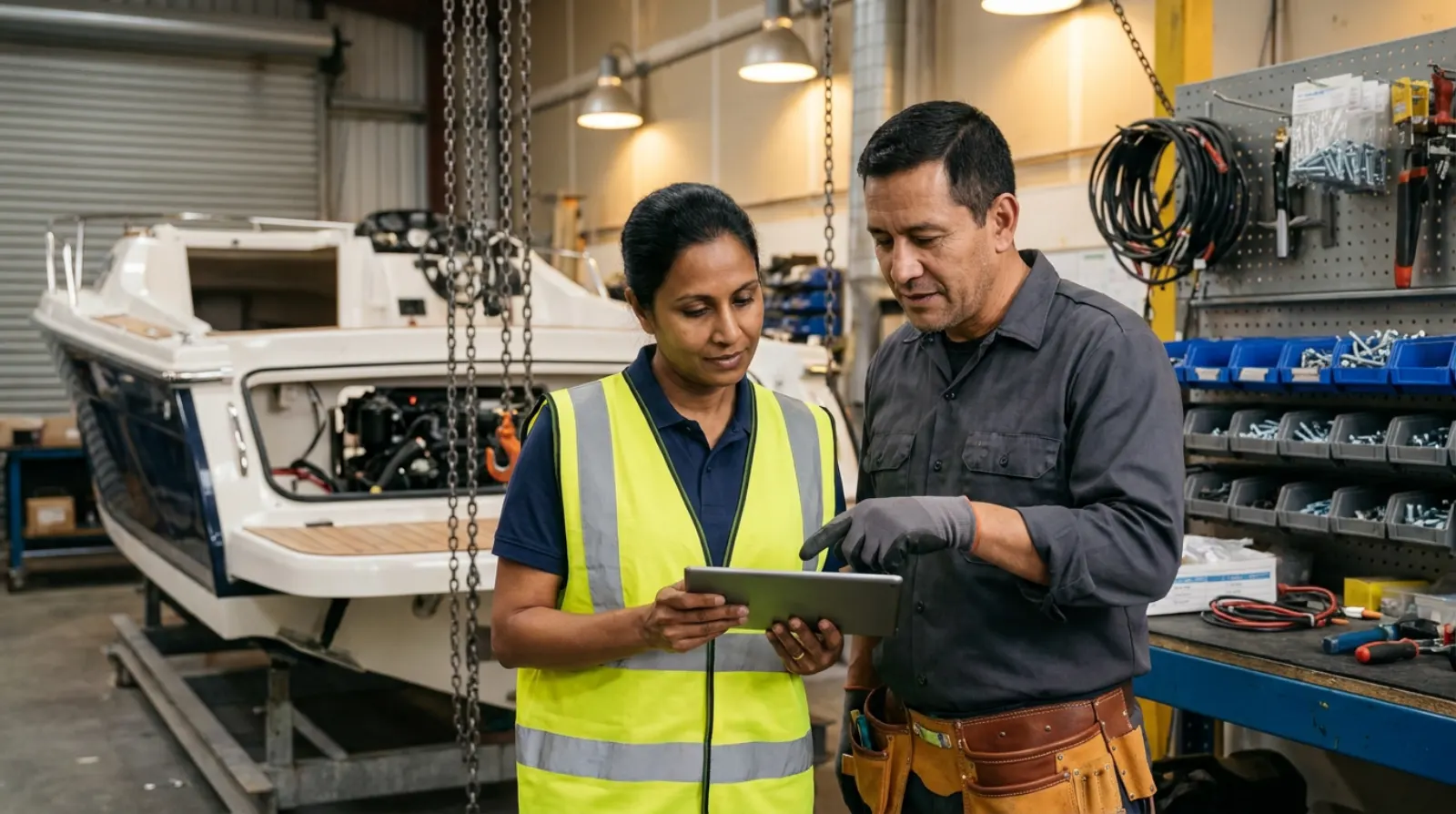

Two team members reviewing consumption numbers

Calculate bin quantities

Determine container sizes using consumption rates and verified vendor schedules

Determine required container quantities

A single formula establishes required containers for a part at an active station. Low-volume manufacturing produces modest results, often below one whole bin. This represents standard behavior for customized operations, so fractional results should never cause alarm. Base consumption figures on actual production records from the floor rather than broad monthly forecasts, ensuring your math matches the real work moving through the building.

N = D × L × (1 + S) ÷ C
DDaily consumption shows pieces consumed each working day at this location, named D
LLead time represents working days required to pick or receive parts, denoted as L
SSafety factor represents a percentage cushion for variation, denoted as S, typically 15 to 30 percent
CContainer size represents total individual pieces stored in one bin, denoted as C

Runner calculation for common hardware

20 × 3 × 1.25 ÷ 100=0.752 bins

A mechanical assembly station consumes 20 fasteners per working day, so daily demand D is 20. The local distributor delivers replenishment stock in 3 working days, making lead time L equal to 3. Reliable deliveries mean the safety factor S is 25 percent. The storage bin holds 100 fasteners, making capacity C equal to 100. That produces 0.75, which rounds up to the required minimum of 2 bins so a reserve sits ready during replenishment.

Repeater calculation for shared assemblies

0.5 × 10 × 1.3 ÷ 4=1.6252 bins

A pump installs on half the orders, giving an average daily demand D of 0.5 per working day. The distributor takes 10 working days, so lead time L is 10. Long lead times increase risk, setting safety factor S to 30 percent. A container holds 4 pumps, so capacity C is 4. Dividing 6.5 by 4 yields 1.625. This rounds up to 2 containers, providing 8 pumps across the loop.

Round calculations up to the next whole container, as stockouts cost more than modest safety stock. Review numbers each quarter against 90 days of actual production, or immediately when assembly schedules shift toward larger builds.

Use the free calculator to size your station bins

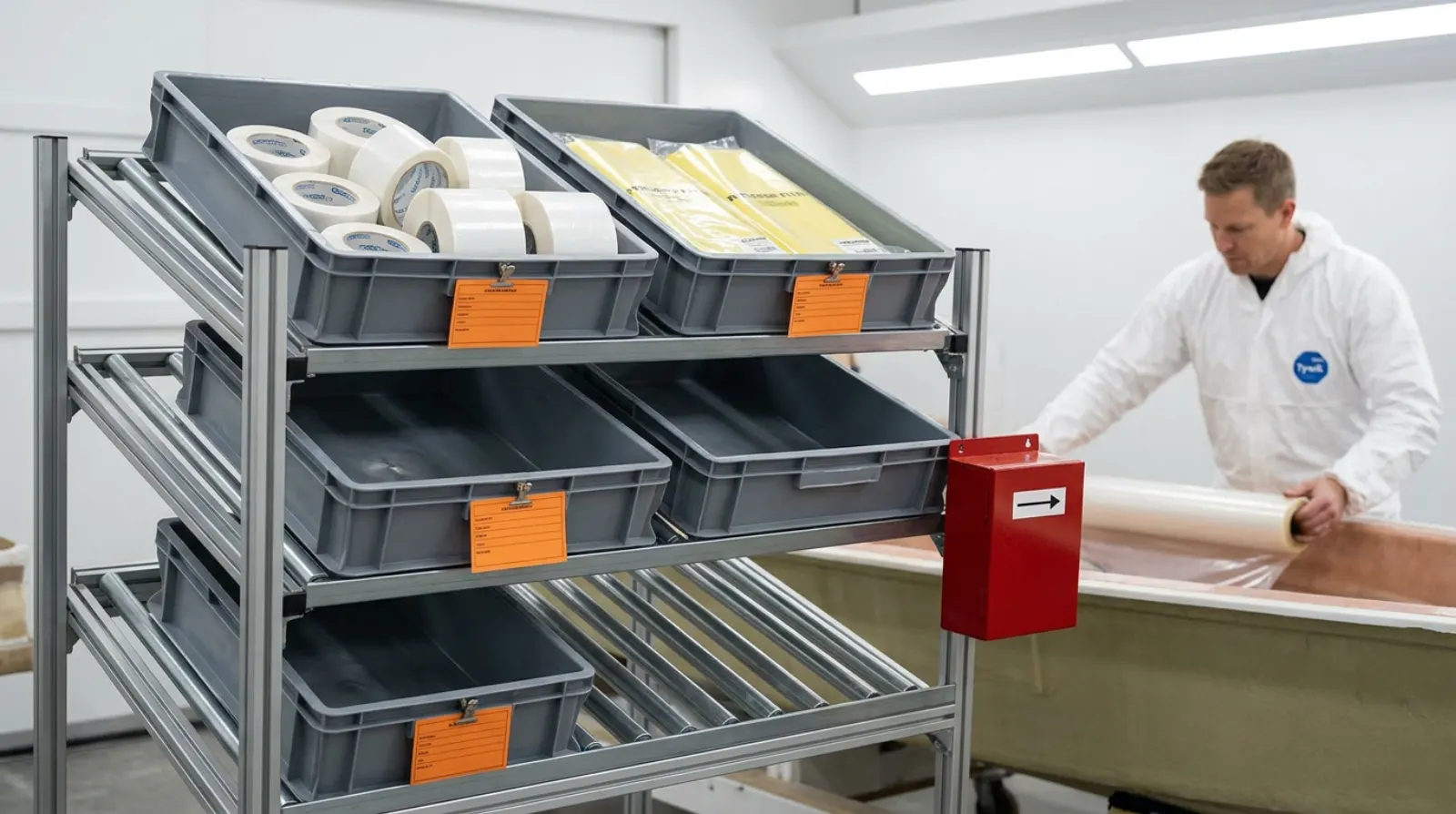

A gravity-flow rack of paired bins beside a work area

Workstation visual design

Stage components directly at the point of installation based on part classification

Position components at the station

Stage every Runner directly where hands assemble parts, within reach of technicians. When components sit far from the work area, technicians lose valuable production time walking across the building. Organizing hardware near active hands eliminates needless searching. Three distinct staging setups accommodate common high-mix components, matching the specific storage method to the physical shape and replenishment speed of each inventory class.

A gravity-flow rack with a return lane and a collection box

Gravity racks

Place gravity racks for Runners two steps from the assembly fixture. Stack lanes two bins deep so the reserve slides down when an operator drops the empty container into the return lane.

The material handler route links every station together across the plant. Walking the identical loop on a set schedule during both busy and slow production periods establishes confidence for operators. Without that steady cadence, technicians stop trusting the system and visual cards become discarded scraps.

A box of spare tape and fasteners hidden under a workbench

Common breakdown points

Floor replenishment systems risk abandonment within six months without disciplined maintenance

Five points of system failure

Every common breakdown stems from recognizable habits on the floor. Applying clear operational rules protects visual replenishment over extended production runs.

Excessive scope

Placing kanban cards on expensive custom components ties up capital in stagnant inventory. Keep Strangers on schedule-driven purchasing, restricting physical cards to shared Runners and Repeaters.

Floor hoarding

Technicians who fear runouts stash backup hardware in toolboxes. This hides true demand from the handler and skews reorder data. Maintain routine 5S sweeps to build stock reliability.

Audit station inventory using the free 5S tool

Unmanaged cards

Setting up cards without clear rules leads to discarded signals. Enforce the standard that cards remain attached to bins or rest inside the return box, accompanied by regular handler sweeps.

Outdated quantities

Container sizes based on past production cause shortages when product mix shifts to larger units. Recalculate container quantities every quarter using the previous 90 days of actual consumption data.

Supervisor raiding

Supervisors take parts from neighboring workstations to push an urgent build, which triggers incorrect reorders across the line. Address unexpected component shortages through root-cause analysis instead of informal line raiding.

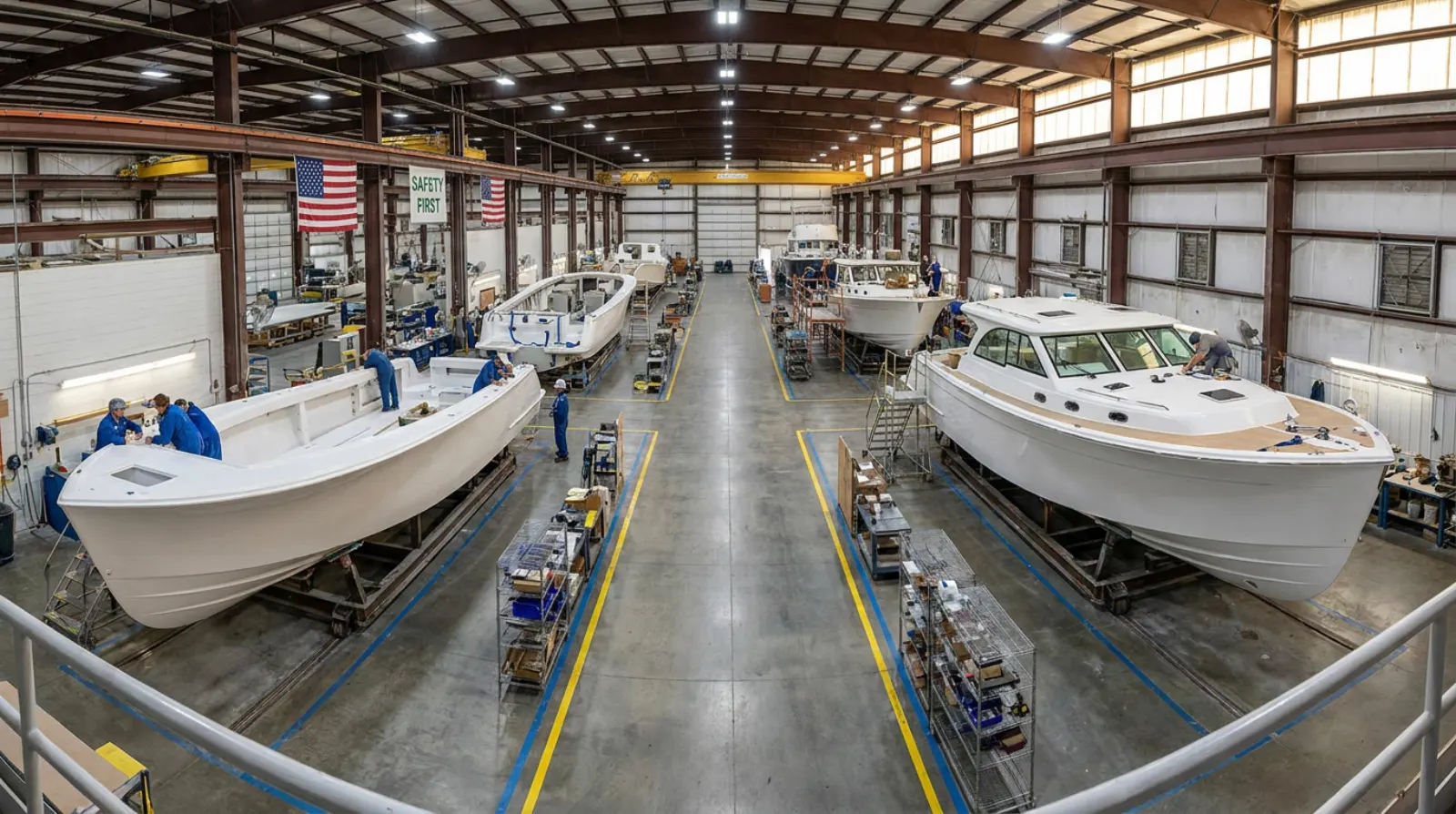

Boat hulls on cradles along the aisle of a production boat yard
Case

Visual replenishment at a production boat builder

Here is one real application of the principles above at a production boat builder. The yard finishes roughly one craft every 6 working days, with specifications changing hull to hull. Kaizumi created a full training course for the production team from the yard's own parts, stations, and process.

Ben, a laminator with 15 years of experience at the yard, was sealing vacuum bags on a 39-foot hull when his station ran out of sealant tape. He walked to the central stockroom, waited 11 minutes at the counter, and walked back, losing 37 minutes. The curing resin approached its application window, putting the hull at risk because nobody had reordered tape.

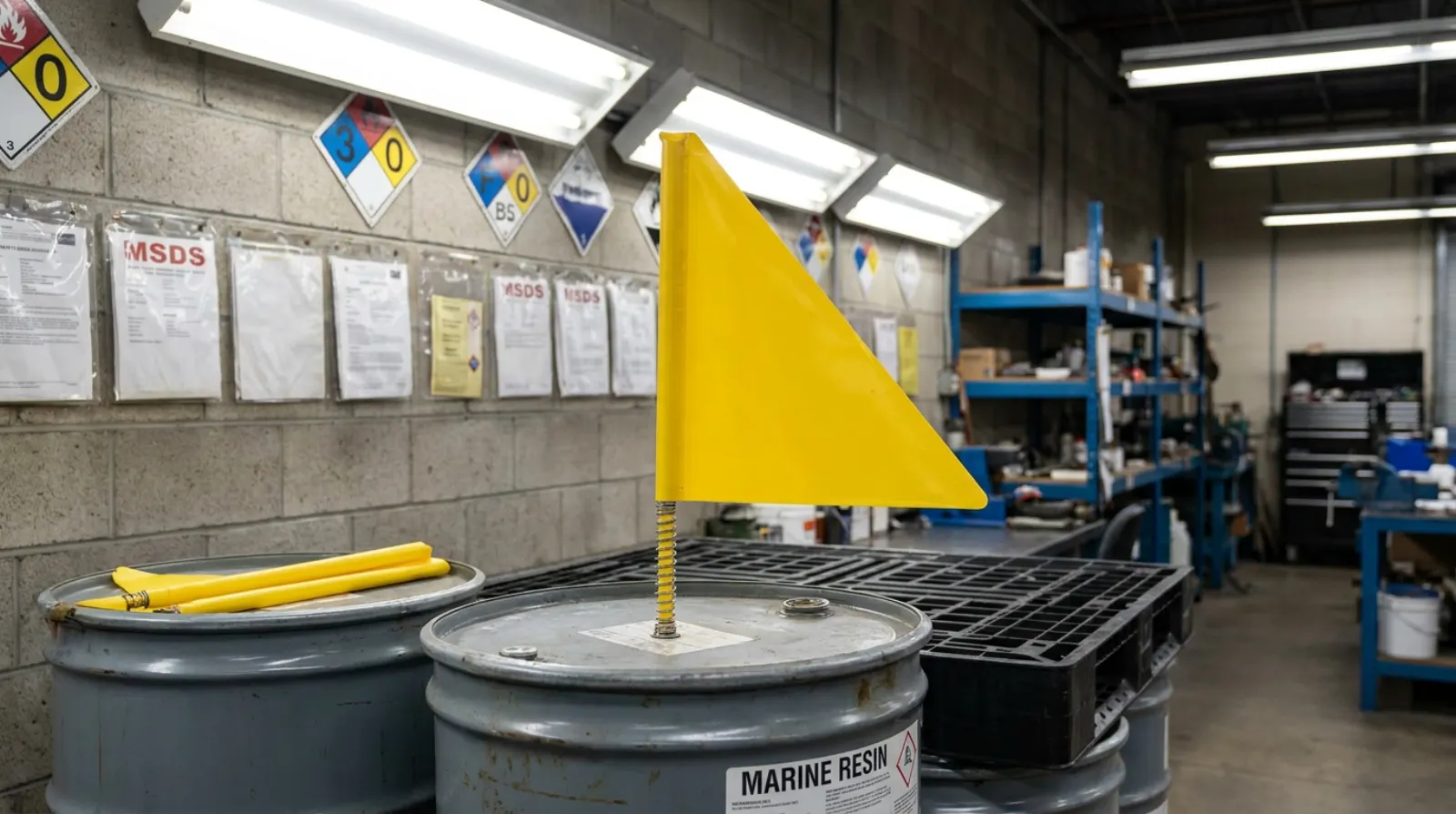

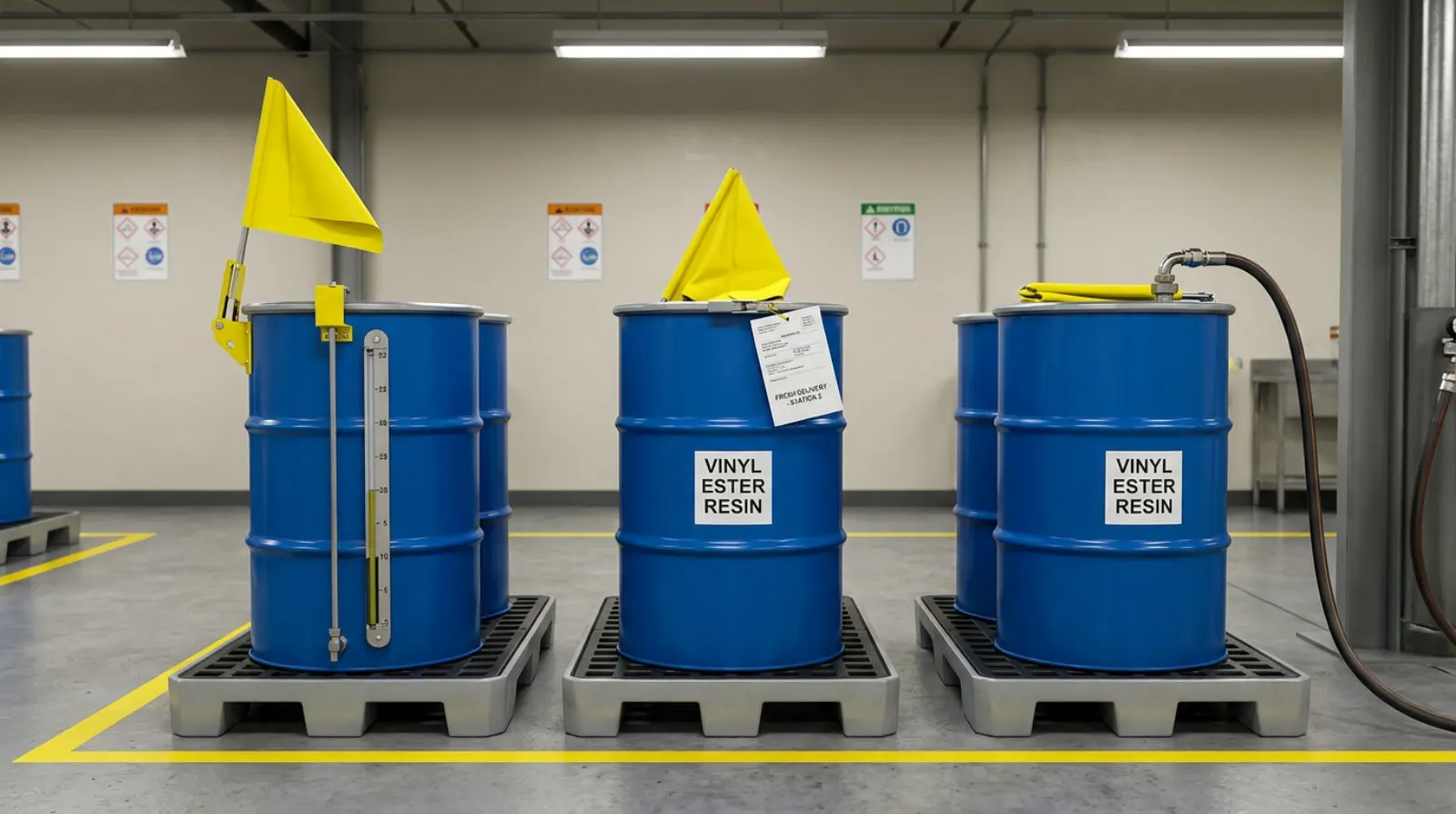

The yard introduced two-bin gravity racks for tape, peel ply, and breather fabric at lamination stations. Elena now checks yellow flags on bulk resin drums along her 90-minute sweep. Joinery hardware moves on dedicated kitting carts built from individual boat orders, while engines remain on scheduled purchasing. Priya and Tomás evaluate bin quantities each quarter.

Six weeks into the rollout, Ben had worked 3 full weeks without walking to the warehouse. During the scheduled review, expanding production of larger craft increased bolt usage from 20 to 35 each working day, prompting the team to resize the station containers.

The full course · 10 lessons · 23 minutes

The complete course includes 10 lessons detailing this boatyard rollout. Follow the sequence from beginning to end or select specific modules covering station hardware and calculations.

The Thirty-Seven-Minute WalkLesson 1 of 10 · 0:54

Part 1

Part 2

Part 3

Part 4

Built by Kaizumi for the yard. Similar tailored training is available for your facility.

Request a curriculum overview

Three steps for this week

  1. 1Log shortagesWalk the assembly area and record every component technicians searched for over the past 30 days, noting warehouse trips and assembly delays.
  2. 2Segment partsClassify recorded parts into Runners, Repeaters, and Strangers. Separate common consumables from order-specific hardware before designing storage.
  3. 3Pilot one loopSelect one Runner, calculate required bin quantities, write out the physical card, and introduce the two-bin setup at tomorrow's team huddle.

Develop custom training for your team

The boat builder course came from one yard's parts, stations, and people. Kaizumi creates identical courses structured directly around your own process, your parts, and your operational language.

Request a curriculum overview

Frequently asked questions

Can pull signals function effectively when product configurations vary continuously?
Yes, when applied to shared hardware and consumables used across multiple product configurations. It is not intended for expensive, order-specific components with irregular consumption patterns. Segment parts into Runners, Repeaters, and Strangers first, then install visual bins strictly for the common Runners and selected Repeaters.
How do manufacturers classify parts into runners, repeaters, and strangers?
Runners are high-volume, low-cost parts used across most products, managed with visual two-bin loops at the station. Repeaters are intermediate items with irregular demand, replenished through preset reorder points. Strangers are high-cost, custom parts purchased strictly against customer bills of materials using standard material requirements planning.
How do you calculate kanban bin quantities for fractional demand?
Use the standard formula combining daily consumption, replenishment lead time, and safety allowance, divided by container capacity. If demand is 0.5 parts per working day, lead time is 10 days, safety is 30 percent, and bins hold 4 parts, the calculation yields 1.625. Rounding up establishes 2 bins holding 8 parts.
How many containers are needed at minimum for each station part?
The minimum is 2 bins per part number at each station. One container remains open for active production while the second full container serves as reserve inventory while the empty bin moves through picking and replenishment. Always round fractional calculation results up to ensure continuous coverage.
How often should production teams recalculate bin quantities?
Recalculate bin quantities every quarter using the previous 90 days of actual consumption data from the shop floor. Recalculate earlier if the production schedule shifts toward larger products or variants that alter daily consumption rates of common components across workstations.
