Final assembly hall with cars on the moving line
Lean, made visible · No. 02

Somewhere in this building, a part is racing a car it has never met.

They will meet at one station, within seconds of schedule — and it will happen again the next minute, and the next, hundreds of times a shift. This is how a Toyota assembly plant works.

System: Toyota Production SystemScope: final assemblyReading time: ~7 min, scrolling
Scroll to begin
Act I · The pace

A factory is a clock.

Before a single bolt is turned, the plant sets its heartbeat. Take the working minutes in a shift and divide by the cars customers want: 450 minutes ÷ 450 cars = one car every 60 seconds. Toyota calls this takt — from the German for a musical beat. Demand sets the pace. Not the machines, not the managers.

Our plant and its numbers are illustrative — the math is the real thing.
Act I · The pace

The line never sprints. It never rests.

Every station on the line gets the same 60 seconds — one shared beat, all shift long. That single rhythm is what lets hundreds of people build one car as if with a single pair of hands. Finish early and you wait; finish late and you're working in the next car's time.

Act II · The station

One operator. One minute. Three rules.

Station 14, trim line. The minute here isn't improvised — it's standardized work, defined by exactly three elements: the takt time, the work sequence, and the standard in-process stock. The same minute, every car — not because anyone demands obedience, but because it's the best way the team has found. So far. Now turn around and watch it happen, one element at a time.

Act II · Element 1 of 5

Pick the harness. 6s

The cycle starts at the rack — never deeper than arm's reach. The bin presents the harness at waist height, label out, the coil oriented the way the hands will use it. One reach, no searching.

Act II · Element 2 of 5

Route it through the door. 14s

Three steps to the car — the harness feeds through the door aperture along the same datum path, every time. The longest walk in the cycle, and it's three steps. That's not luck; the rack was placed so it would be.

Act II · Element 3 of 5

Seat the connectors. 12s

Four connectors, each with an audible click. The click is a built-in quality check — confirmation by feel and sound, no inspector needed. Remember it: it shows up as a ◇ on a chart in a moment.

Act II · Element 4 of 5

Install the cowl trim. 16s

The longest element. The trim panel comes off the rack's lower lane already oriented the way it installs — no flipping, no untangling, no judgment calls. Sixteen seconds of pure assembly.

Act II · Element 5 of 5

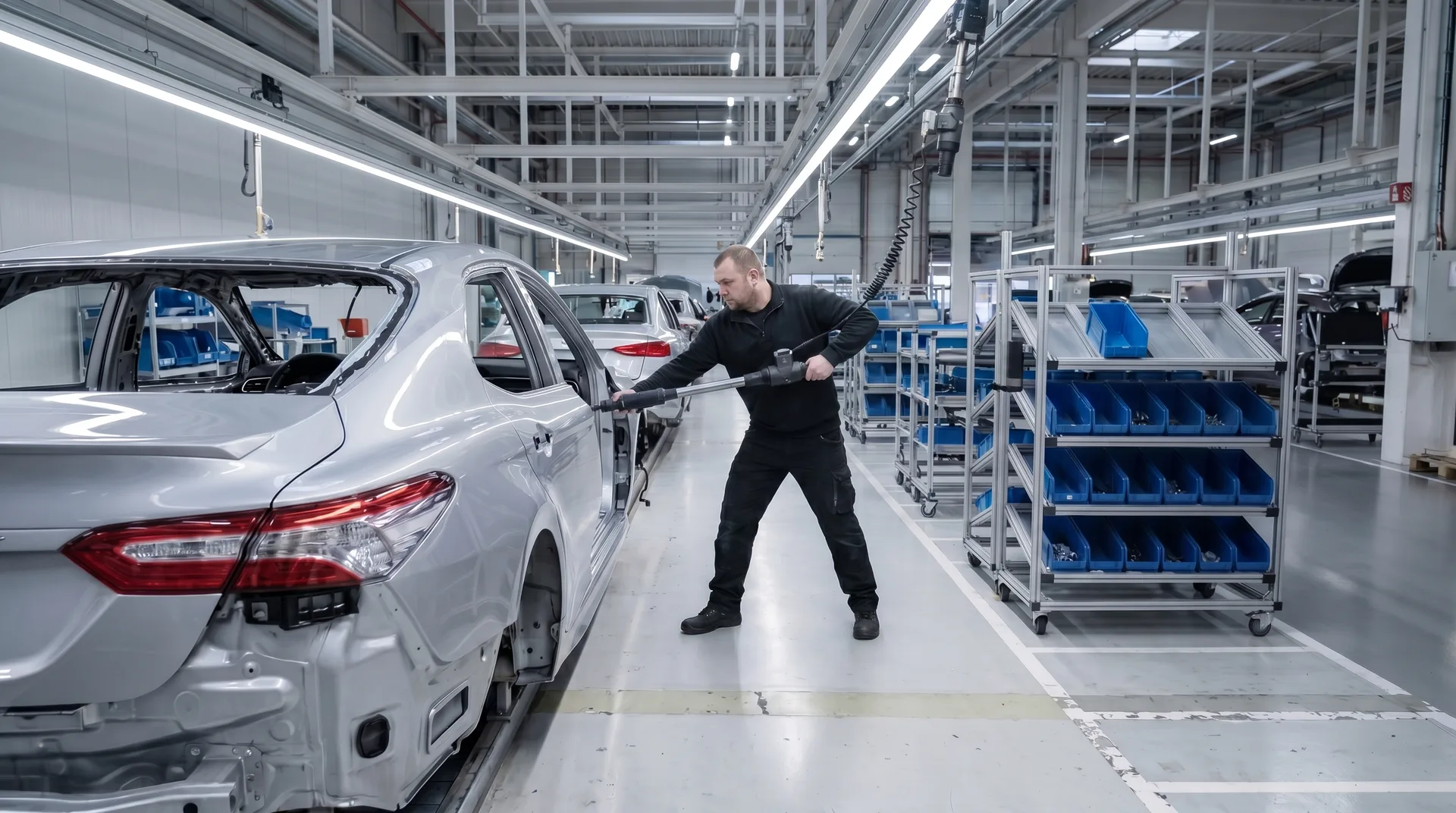

Torque, scan, walk back. 10s

The hanging torque tool records every fastener — count and final torque, logged to this car's serial. The scan closes the cycle; the walk back ends where it began. Σ 58 seconds, against a takt of 60. Not hustle — choreography.

Act II · The station

And it's all on one page.

The minute you just watched lives on a single drawing posted at the station: the standardized work chart — the station's real geometry from above. The car on the line, the rack, the tool; the numbered walking path; the connector quality check, the torque-tool safety point, the standard WIP — one car at the station. Anyone — operator, team leader, engineer — can read this job at a glance.

Form 3 of standardized work's three documents (with the process capacity table and the combination table). Build one for your own station → kaizumi.com/tools/swc
Act II · The station

Stack the work. Drop the line.

Chart every station's minute as a stacked bar and you get a yamazumi — "piled-up" work against the red line of takt. Each element is colored by the area of the vehicle it touches: a bar that keeps changing color is an operator forced to wander around the car. The skyline must sit under the line — and at Toyota these are living documents: elements on magnetic strips, physically rearranged whenever takt or the model mix changes.

We built a whole guide about balancing one of these → guides/yamazumi · or stack your own line → tools/yamazumi
Act III · When something goes wrong

The cord.

A connector won't seat. The bolt cross-threads. The part looks wrong. Any team member pulls the andon cord — music plays, a light flares on the board: Station 14. A team leader arrives within seconds. Not to assign blame. To help — while the line keeps moving.

Act III · When something goes wrong

How does a line know something's wrong?

Standardized work is the answer. The job is designed at 58 seconds against a 60-second takt — wound tight on purpose. The moment an operator can't finish in the designed time, that's not a feeling, it's a fact, visible within one cycle. And the help is real: the team leader is an exceptionally experienced operator who can run every station in the zone. That relationship — trouble met with skilled help in seconds, no blame attached — is what lets a system this tight run at all. The point was never to avoid problems. It's to surface them and improve.

Act III · When something goes wrong

Fix it in one beat — or everything stops.

From above you can see the whole bargain. The fixed positions are painted lines across the line itself — and the car hasn't reached the next one yet. The team leader has exactly that much floor to contain the problem. Resolved before the painted line: the line never stops. Not resolved: that section halts, and the problem gets everyone's attention. Toyota wired this in decades ago — line andon in 1969, fixed-position stops in 1971.

What can't be fixed in station goes off-line for repair — famously, the 1992 Georgetown seat problem in HBS case 693-019.
Act IV · Parts at arm’s reach

The operator never fetches.

Look closer at the station. Every part presents itself: gravity flow racks tilt toward the line, small bins slide forward as the last one empties, labels face out, the next part is always at the fingertips. Walking to get parts is waste — so the rack does the walking.

Act IV · Parts at arm’s reach

Some parts ride along with the car.

On many lines Toyota goes further: a material handler pre-picks this exact car's parts into a kit tray that travels inside the car down the line — the Set Parts Supply (SPS) system. The operator picks from the tray at their elbow; the walking and searching moved to dedicated handlers, stationed roughly every 7–10 stations.

As observed at Georgetown and a Toyota engine line in Japan, 2009 (Art Smalley / LEI).
Act V · The signal

The empty bin is the order.

Nobody at Station 14 types an order for more harnesses. When the operator takes the first part from a new bin, a card comes off the bin and drops into a post box. That card — the kanban — is the order, the address label, and the inventory system, all in one piece of laminated paper.

Act V · The signal

A loop, not a list.

The card travels to the supermarket; a full bin travels back; the card clips onto the new bin and waits to be freed again. Consumption pulls replenishment — nothing moves unless something was used. Toyota digitized the card's journey (e-kanban: five plants in 1999, every plant by 2002), but the loop's logic hasn't changed.

Act VI · The supermarket

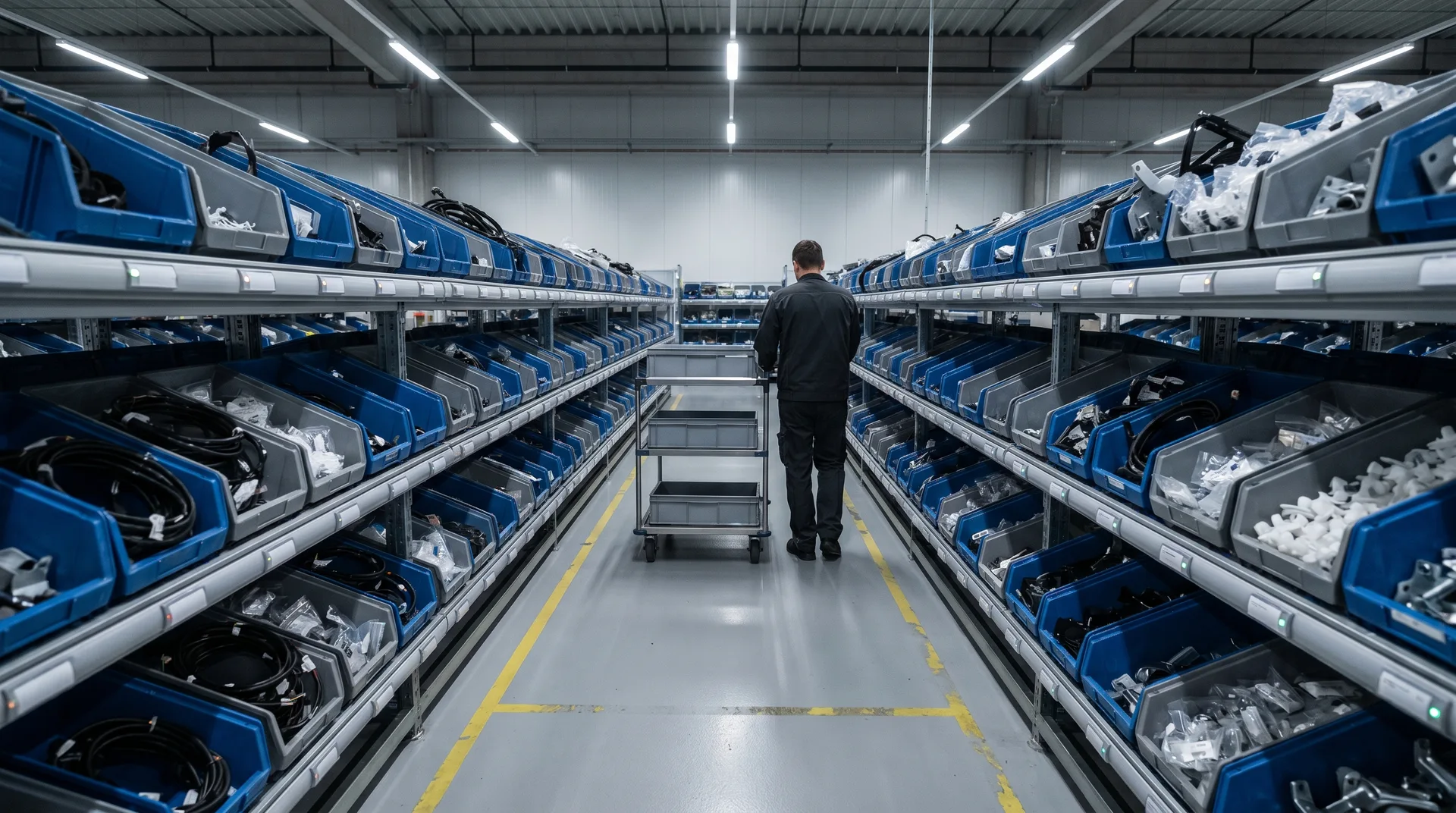

A store inside the factory.

The bins come from the parts supermarket — named, literally, after the American self-service grocery stores that inspired it. Every part has a fixed address (D-3-2: aisle D, rack 3, level 2), a minimum and a maximum. The shelves are deliberately small: inventory hides problems, so the store stays lean enough to expose them.

Act VI · The supermarket

Lights tell the hands where to go.

A picker working a kit cart doesn't memorize addresses. In modern kitting areas, light-directed picking does the navigation: a lamp lights at the right shelf, a display shows the quantity, a button press confirms the take. The information arrives exactly where the hands already are — same principle as the kanban card, at walking speed.

Light-directed picking is standard practice in automotive kit areas; Toyota signals its SPS pickers electronically.
Act VII · The routes

The milk run.

No forklift wanders this plant with a full pallet and good intentions. Parts move on tugger routes: a fixed loop, fixed stops, a fixed timetable — like a city bus. The documented pattern: a tugger leaves the market on the hour, hits every stop in order, returns in 30 minutes, then does it again, all shift. Small amounts, delivered often, on a schedule you could set a watch by.

Pattern per Rick Harris (former Toyota Georgetown manager), "Making Materials Flow" — documented at a non-Toyota supplier plant, early 2000s.
Act VII · The routes

Some of the drivers are robots.

Upstream in Georgetown's body weld shop, the route drivers are automated: a fleet of 100+ AGVs — 22 guided tuggers hauling stamping parts, 79 guided carts ferrying finished subassemblies, 4 conveyor-top units — moving more than 1.8 million parts a year along the same logic a human milk run follows.

TMMK body-weld shop as reported in 2012 (Modern Materials Handling) — upstream of final assembly.
Act VIII · The system

One building. One heartbeat.

Now hold it all in view at once: the line beating at takt, andon watching every station, kits riding inside the cars, kanban cards cycling like blood cells, tuggers tracing their loops past a supermarket that breathes in and out. At Georgetown that organism spans 7.5 million square feet and builds roughly half a million vehicles a year. It isn't a collection of machines. It's a system that knows what time it is.

TAKT = 450 min ÷ 450 cars = 60 sillustrative
ROUTE 3 · TIMETABLE
dep. supermarket :00
12 stops · fixed order
back at dock :30
every 30 min, all shift
GEORGETOWN, KY (TMMK) · 2012
7.5M sq ft under one roof
500K vehicles/yr capacity
6,600 team members
Lineside workstation: car body on the line beside a gravity flow rackStation 14 · trim line — illustrative scene
STANDARDIZED WORK — 3 ELEMENTS
1 takt time · 2 work sequence · 3 standard in-process stock
GRAVITY FLOW RACK
parts slide to the fingertips
SMALL BINS · POINT OF USE
label out · heavy parts at waist height
empty bin returns on the top lane

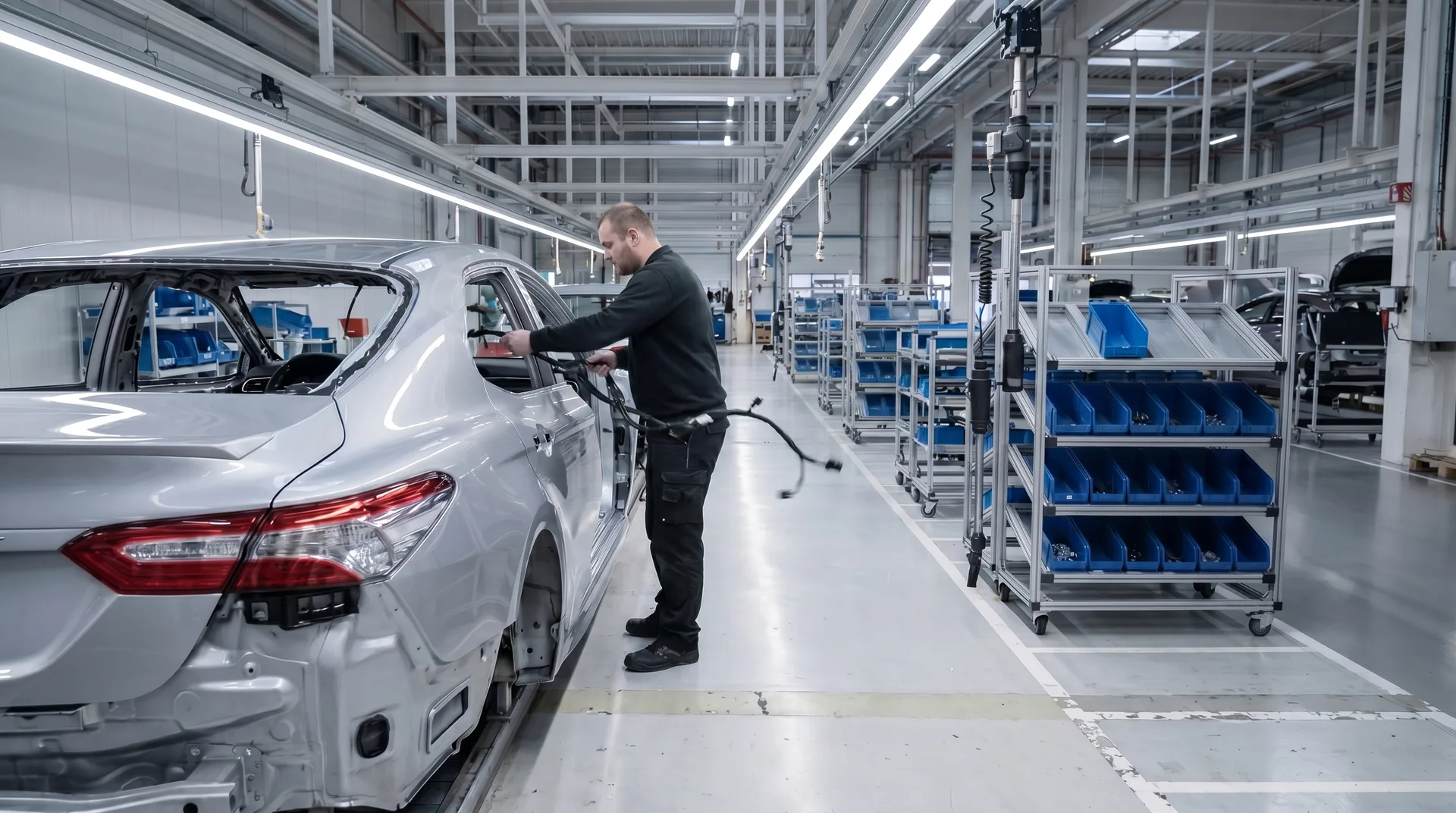

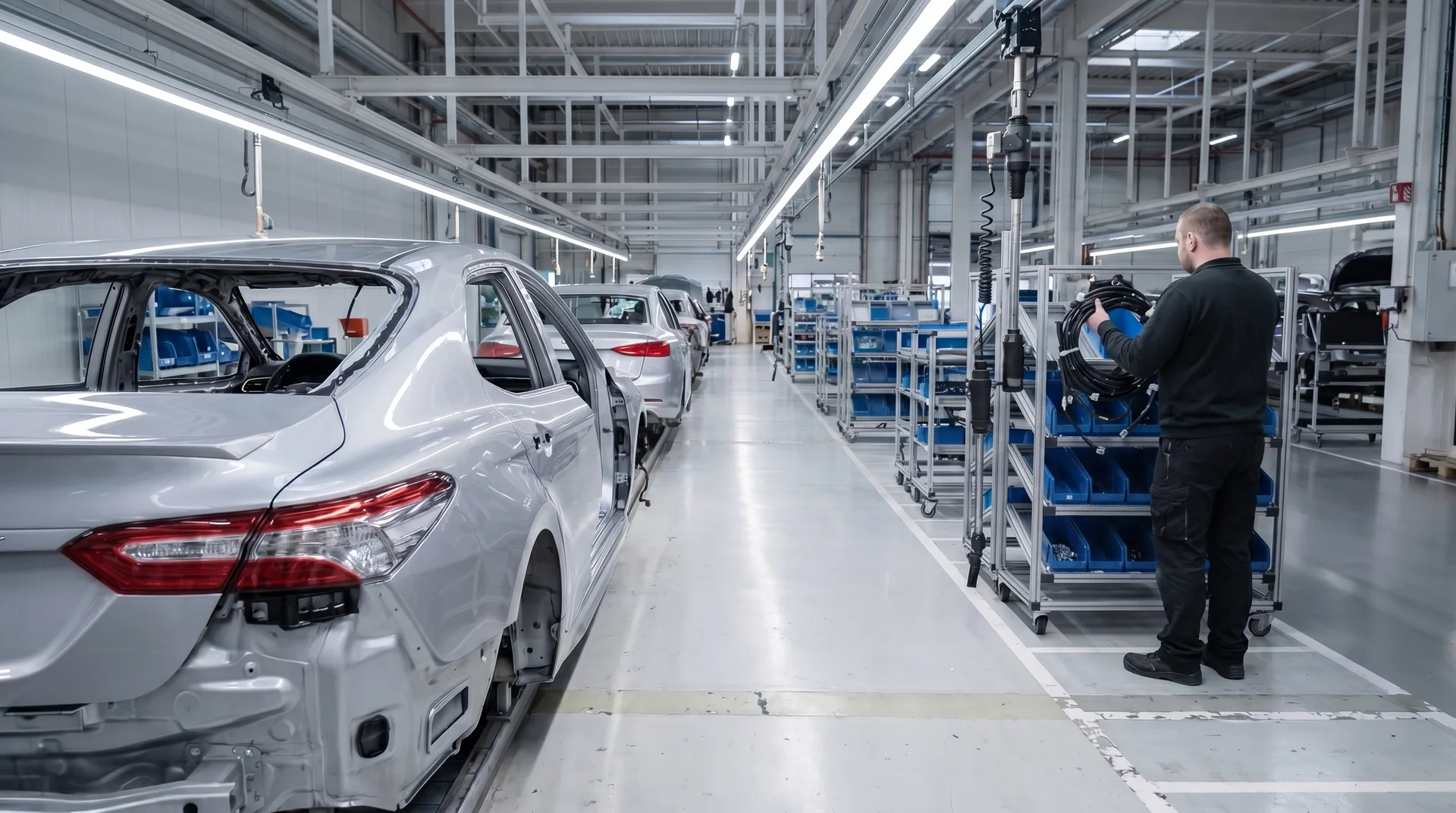

Operator picking a wire harness from the flow rackOperator routing the harness through the door apertureOperator crouched at the door sill seating connectorsOperator installing the cowl trim panelOperator using the hanging torque tool at the doorStation 14 — one cycle, element by element
12345
WORK ELEMENTS · ONE CYCLEΣ 58s
1 · Pick harness at rack6s
2 · Route harness thru door14s
3 · Seat connectors + clips12s
4 · Install cowl trim16s
5 · Torque, scan, return10s
Operator reaching up to pull the yellow andon cord above the lineThe pull — any team member, any reason, any time
ANDON · TRIM♪ PLAYING
111213141516

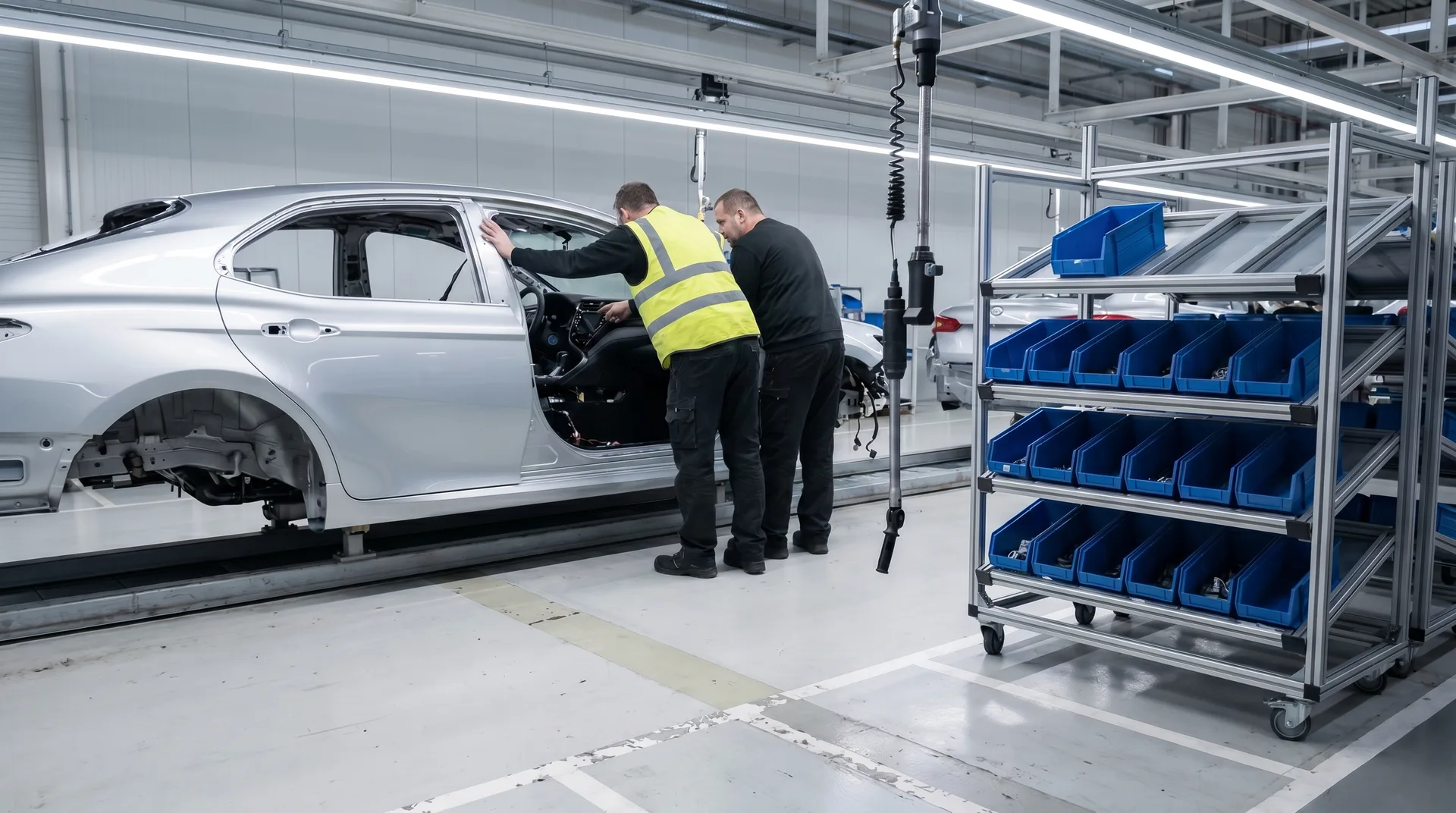

Team leader in a hi-vis vest helping the operator at the car door
ANDON · TRIM♪ PLAYING
111213141516
STATION 14
DESIGNED 58s
THIS CYCLE 64s
▲ +6s — the job itself reports the problem
TEAM LEADER · ZONE 3
An exceptionally experienced operator — can run every station in the zone. Carries no regular cycle; exists to respond.

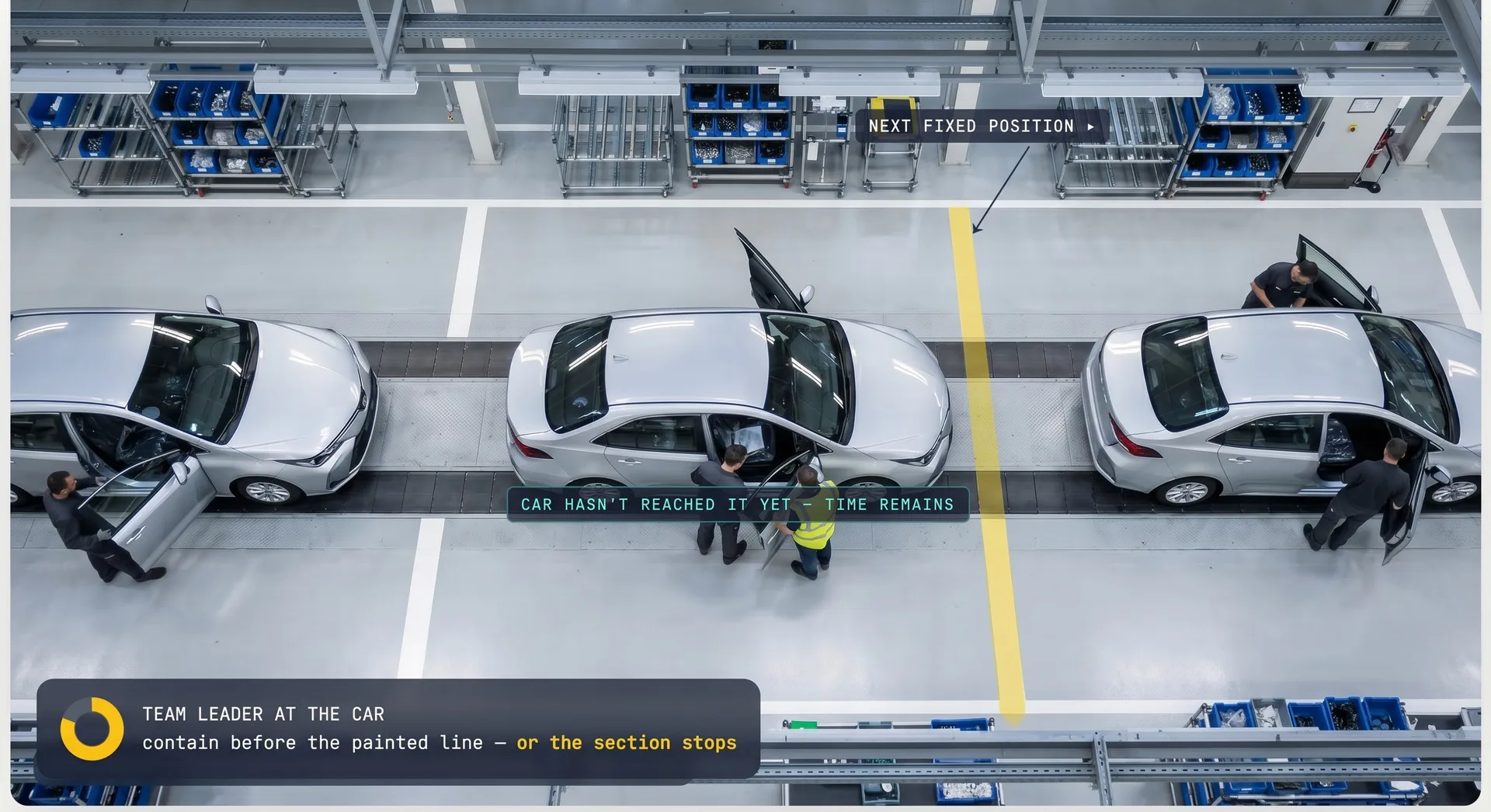

Overhead view of the line with painted fixed-position lines; the car has not yet reached the next line

SPS kit tray with vehicle-specific parts riding inside the car bodySPS kit tray riding inside the car — Georgetown, observed 2009
Parts supermarket aisle with flow racks full of totes and a picker with a kit cartParts supermarket — illustrative scene
PICK
D-3-2
QTY 8 · HARNESS, DOOR FR
✓ press to confirm
Electric tugger pulling a train of carts with totes down a plant aisleTugger train on a delivery loop — illustrative scene
TAKT · 60s
every bar under the line, loaded close to takt — the full method → guides/yamazumi
Glass run ch. · 18s
Door seals · 20s
Wiring clips · 14s
ST-12
52s
Mirror mount · 16s
IP brackets · 22s
Grommets · 19s
ST-13
57s
Door harness · 32s
Cowl trim · 16s
Torque + scan · 10s
ST-14
58s
Carpet edge · 21s
Pedal trim · 14s
Sill plates · 14s
ST-15
49s
IP harness · 24s
Defroster duct · 13s
A-pillar trim · 18s
ST-16
55s
COLOR = AREA OF THE VEHICLEDoorCowl / IPUnderbody
PARTS WITHDRAWAL KANBAN3 / 5
Part No.82152-0E140
DescriptionHARNESS, DOOR FR
Qty / Bin8
Store FromSUPERMARKET D-3-2
Deliver ToST-14 · TRIM LINE
WHAT — part number & name
HOW MANY — one bin, fixed qty
FROM WHERE — shelf address
TO WHERE — exact lineside spot
STANDARDIZED WORK CHARTFORM 3
PROCESS DOOR HARNESS + COWL TRIMSTATION 14 · TRIM LINEPREPARED BY TEAM 3
ASSEMBLY LINE · CAR MOVES ▸◂ DOOR APERTURECAR — STATION 14TORQUE ARMGRAVITY FLOW RACK12345CONNECTOR CLICK CHECK
Takt time60s
Cycle time58s
Margin2s
Std WIP1
Operators1
○ work step– – walking path◇ quality check✚ safety precaution● standard WIP⤺ return walk
Posted at the station, drawn by the team. Build yours → kaizumi.com/tools/swc
Now it's your floor

Walk your own line.

Every idea in this story — takt, standardized work, andon, kanban, milk runs — works the same in a hospital, a warehouse, or a six-person shop. Pick one, and go look.

SOURCES · Toyota Motor Corp. 75-Year History (andon 1969/1971 · e-kanban 1999–2002) · Lean Enterprise Institute & Art of Lean (yamazumi, standardized work, SPS observation 2009) · HBS Case 693-019 (Georgetown, 1992) · Modern Materials Handling plant report (TMMK, 2012) · R. Harris, Making Materials Flow (timed-route pattern). Plant layout, Station 14, takt of 60s, and part numbers are illustrative.
Good to know

Frequently asked

What is takt time?
The pace a line must hold to meet customer demand: available working time divided by the number of units customers want. Every station gets the same beat, which is what lets hundreds of people build one product as a single synchronized system.
What happens when a Toyota worker pulls the andon cord?
Music plays and the station number lights on the andon board. A team leader — an exceptionally experienced operator who can run every station in the zone — arrives within seconds to help. If the problem is contained before the car reaches the fixed position (a painted line on the floor), the line never stops; if not, that section halts. Toyota introduced line andon in 1969 and fixed-position stops in 1971.
What are the three elements of standardized work?
Takt time (the pace), the work sequence (the exact order of work elements), and standard in-process stock (the minimum WIP needed to keep flowing). They are documented on the process capacity table, the combination table, and the standardized work chart.
