Work element analysis explained

Work element analysis breaks a job into its smallest steps and times each one. It shows which seconds of the job add value, which are needed and which are waste.

Matt Savas · Reviewed October 2026 · About 6 minutes

What a work element is

A work element is the smallest step of a job that can be timed and moved to another operator. “Install the bracket” is a work element. You can time it, and you could give it to the operator at the next station.

Each element is made of smaller motions. Installing the bracket means picking two bolts, lining up the bracket and torquing the bolts. Picking the bolts is not an element on its own. Nobody would give it to another operator, because it only happens as part of installing the bracket.

Each element also needs an end point you can see or hear, such as the click of a torque gun. Then everyone who times the job stops the watch at the same moment.

What the analysis is for

Work element analysis gives you a list of the elements in a job, in order, with an end point and a time for each one. It also sorts every second into value-added work, needed work or waste. Teams use the list to:

  • Build a yamazumi chart. Each element is one block in an operator's bar on a yamazumi chart.
  • Balance a line. In line balancing, you move whole elements between operators until each one fits under takt time.
  • Find the waste. Once every second is sorted, you can see what to remove first.
  • Write the standard. The elements, their order and their times become the operator's standardized work.

Value-added work, needed work and waste

Every second of a job is one of three kinds of time.

  • Value-added work changes the product the customer pays for, such as torquing a bolt or seating a connector. Keep it.
  • Needed work does not change the product, but the job can't be done without it today. Picking parts, lining them up and checking them are needed work. It is also called necessary non-value-added work. Reduce it.
  • Waste adds nothing and is not needed, such as walking to a rack that is too far away or waiting for a machine. Remove it.

How to do a work element analysis

  1. 1
    Watch the whole job first
    Watch several cycles before you write anything down. Ask the operator what they do and why.
  2. 2
    List the elements in order
    Write down each step that could be given to another operator. Give each one an end point you can see or hear.
  3. 3
    Time each element ten times
    Use a stopwatch at the job, not the planned times. Write down walks and waits too, with their times.
  4. 4
    Use the lowest repeatable time
    For each element, use the lowest time that shows up more than once. Don’t use the average. Slow times come from problems like a missing part or a sticking tool. Fix those instead.
  5. 5
    Sort every second
    Mark each part of each element as value-added work, needed work or waste.
  6. 6
    Remove the waste first
    Take out the waste, then look for ways to reduce the needed work. Leave the value-added work alone.

The free time observation sheet records ten cycles for each element and finds the lowest repeatable time for you. You can then enter the times in the free yamazumi chart builder.

A worked example

An operator at a one-person bench fits a bracket and a connector to a metal housing. The bracket rack stands across the cell. The times are made up, in seconds, for one unit. As you scroll, the chart builds one step at a time.

One unit at the bracket bench
Each step adds one piece to the chart.

Position the housing on the jig
5s

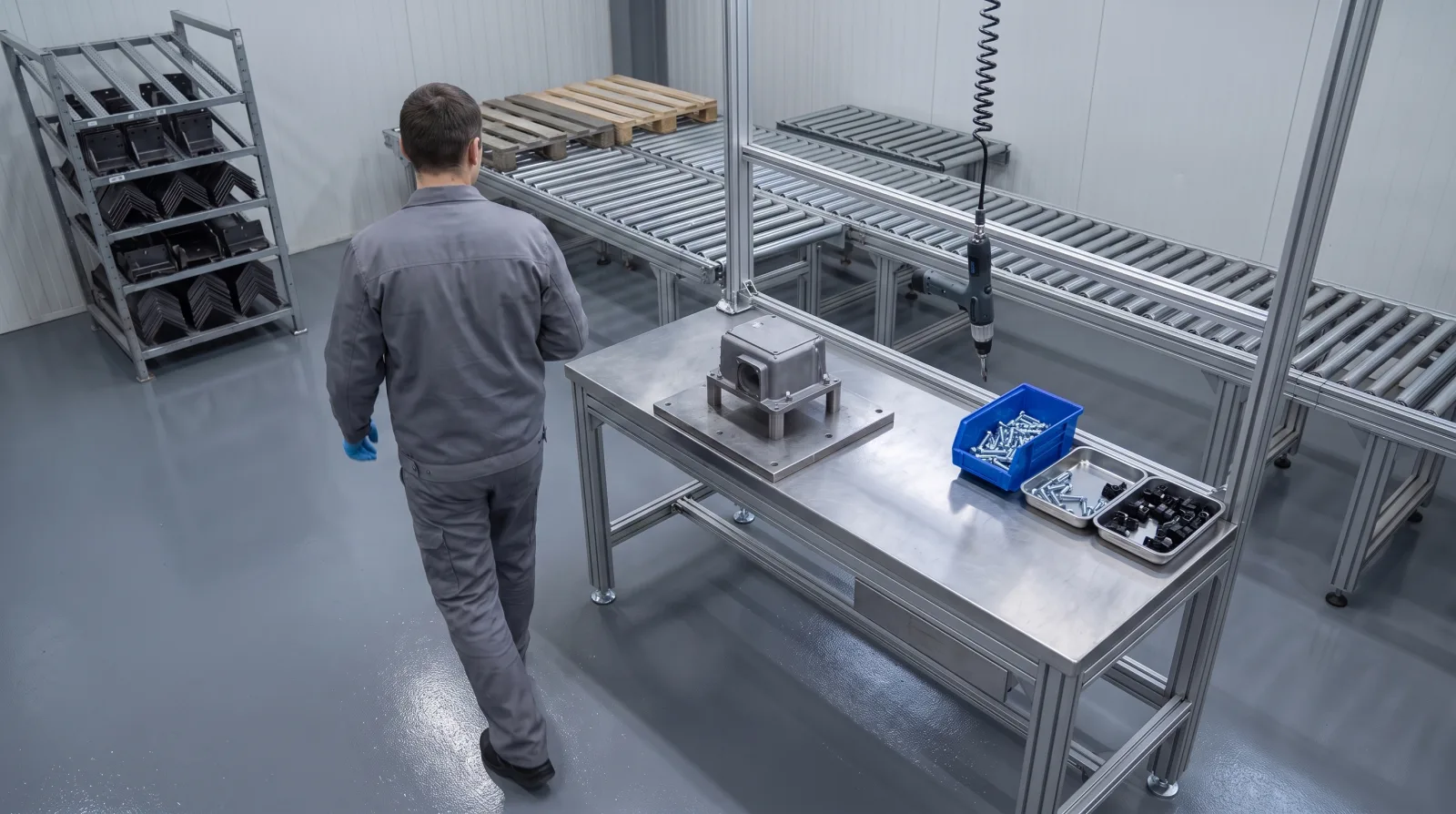

Walk to the bracket rack
8s

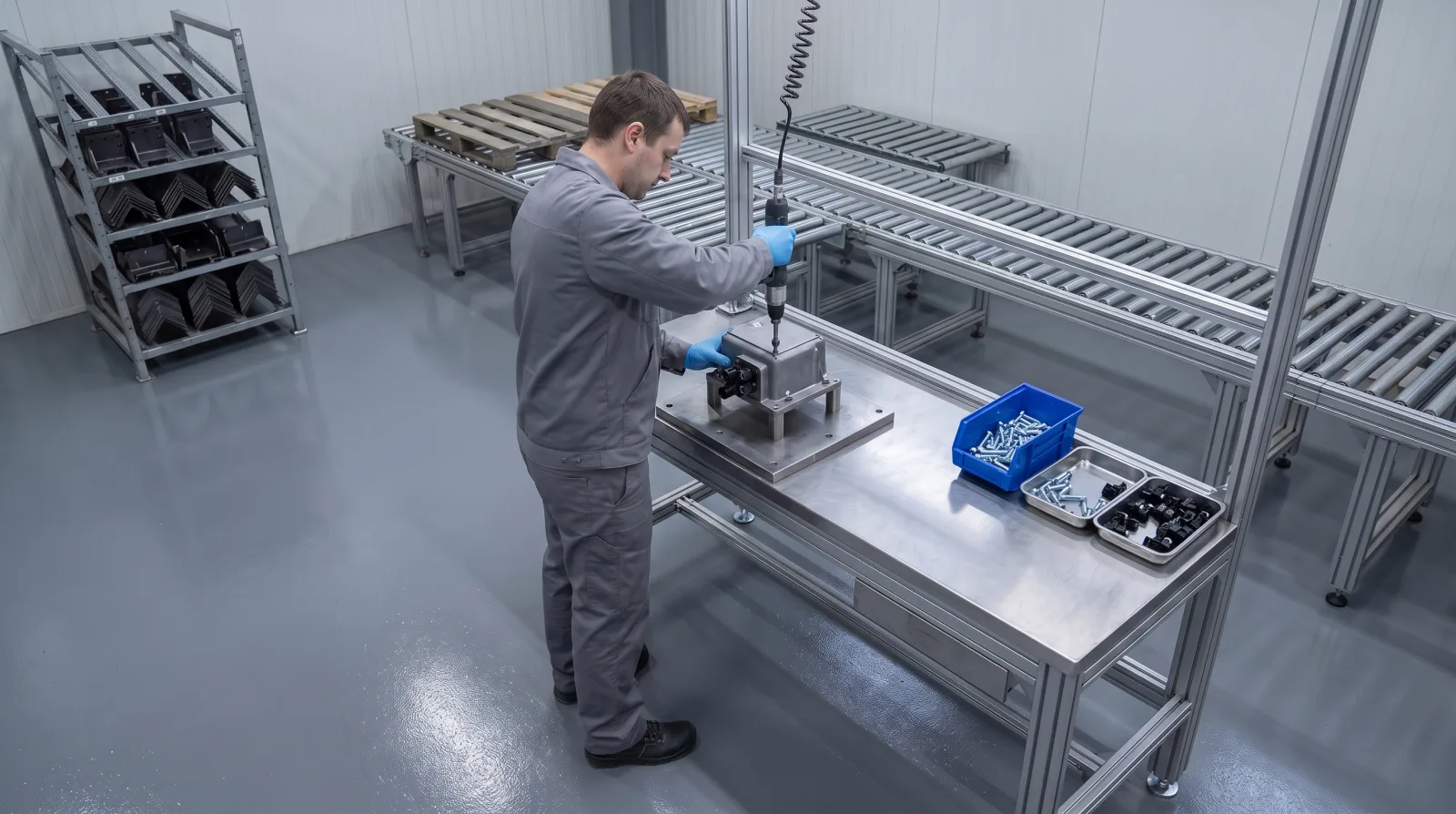

Install the bracket
14s

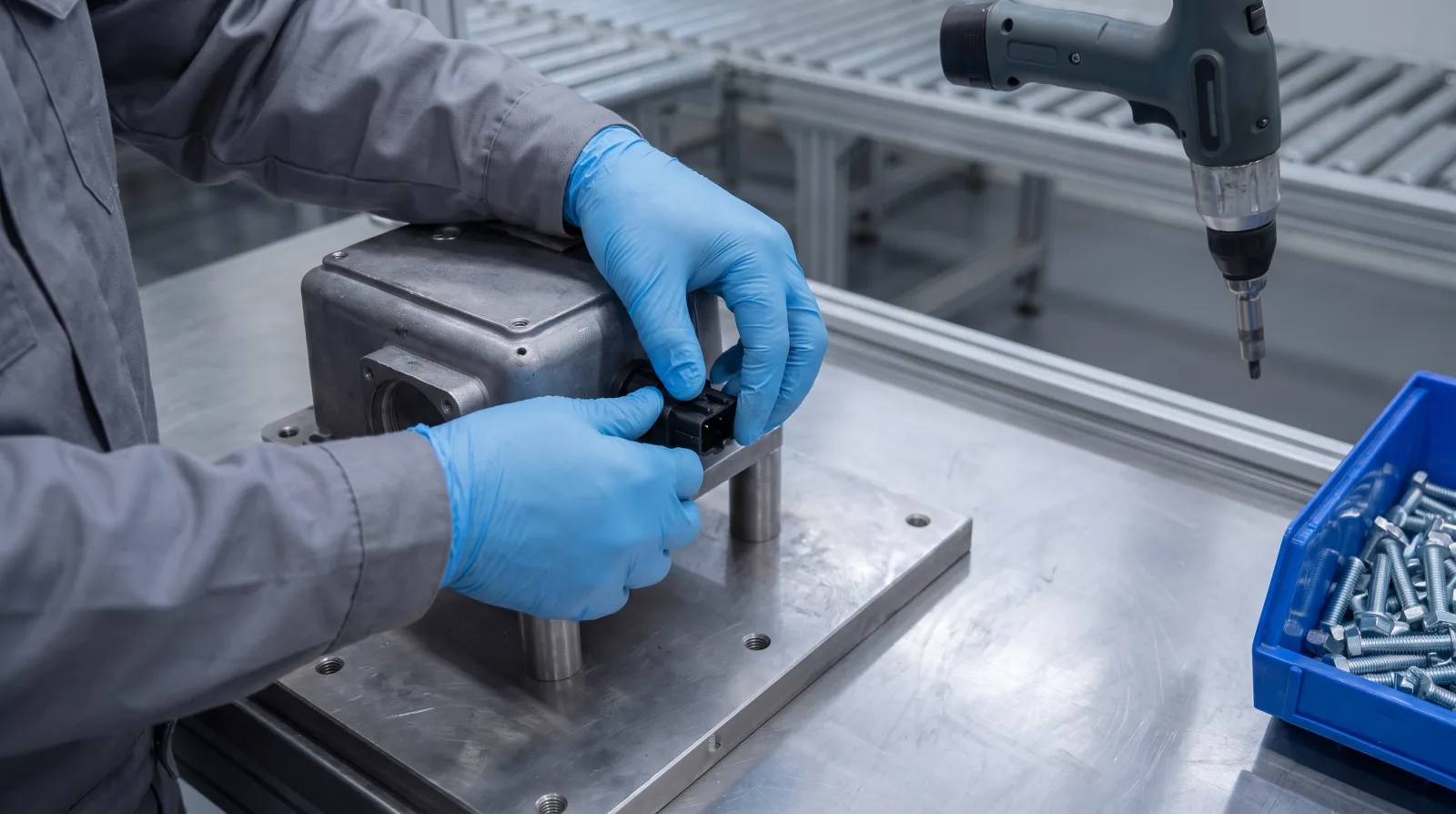

Seat the connector
8s
Inspect and release
5s
One unit40s
Value-added 12s Needed work 20s Waste 8s
Step 1 of 5

List the elements

The job has four elements: position the housing on the jig, install the bracket, seat the connector, and inspect and release. The operator also walks to the bracket rack every cycle. The walk goes on the list too, with its time: 8 seconds. One unit takes 5 + 8 + 14 + 8 + 5 = 40 seconds.

Position the housing on the jig
5s
Walk to the bracket rack
8s
Install the bracket
7s
14s
Seat the connector
5s
8s
Inspect and release
5s
One unit40s
12s
Value-added 12s Needed work 20s Waste 8s
Step 2 of 5

Mark the value-added work

Only two motions change the product. Torquing the bracket takes 7 seconds. Pushing the connector on until it clicks takes 5 seconds. That is 12 of the 40 seconds.

Position the housing on the jig
5s
Walk to the bracket rack
8s
Install the bracket
7s
7s
14s
Seat the connector
3s
5s
8s
Inspect and release
5s
One unit40s
12s
20s
Value-added 12s Needed work 20s Waste 8s
Step 3 of 5

Mark the needed work

Lifting and seating the housing, picking the bolts, lining up the bracket, picking the connector, checking the unit and setting it on the conveyor are all needed. None of them changes the product. Together they take 5 + 7 + 3 + 5 = 20 seconds. Installing the bracket takes 14 seconds, and only 7 of them add value.

Position the housing on the jig
5s
Walk to the bracket rack
8s
Install the bracket
7s
7s
14s
Seat the connector
3s
5s
8s
Inspect and release
5s
One unit40s
12s
20s
8s
Value-added 12s Needed work 20s Waste 8s
Step 4 of 5

Mark the waste

The walk is the last 8 seconds, and it is waste. A 450-minute shift has 27,000 seconds. At 40 seconds a unit, the bench makes 675 units (27,000 ÷ 40). That is 675 × 8 = 5,400 seconds of walking, or 90 minutes, every shift.

Position the housing on the jig
5s
Walk to the bracket rack
0s
Install the bracket
7s
7s
14s
Seat the connector
3s
5s
8s
Inspect and release
5s
One unit32s
12s
20s
Value-added 12s Needed work 20s Waste 8s
Step 5 of 5

Remove the waste

Put the brackets in a bin on the bench, next to the bolts. The walk is gone, and one unit now takes 32 seconds instead of 40, a cycle 20% shorter. The same shift makes 843 units instead of 675 (27,000 ÷ 32 = 843.75). The value-added work did not change, and nobody had to work faster.

The element sheet

The sheet lists each element in order, the point where it ends, and its time. The walk stays on the sheet, marked as waste, until it is removed.

Element sheet for the bracket bench
Each element ends at something you can see or hear.
#Work elementEnds whenTime
1Position the housing on the jigThe housing sits against both stops5s
–Walk to the bracket rack (waste)The operator is back at the bench with a bracket8s
2Install the bracketThe torque gun clicks off on the second bolt14s
3Seat the connectorThe connector clicks into place8s
4Inspect and releaseThe unit is on the conveyor5s
One unit40s
One unit, brackets on the bench32s

Common mistakes

  • Splitting the job too finely. “Pick two bolts” can't be moved to another operator. Time it as part of the element it belongs to.
  • Making elements too big. “Assemble the unit” is one block that can't be split between operators. Break it into steps that someone else could do.
  • Leaving out the end point. If an element ends “when the part is done,” two people will stop the watch at different times. Pick a sound or a movement.
  • Moving waste to another operator. If the walk moves to the next station, someone still walks. Remove it before you balance the line.

Frequently asked questions

What is a work element?
A work element is the smallest step of a job that can be timed and moved to another operator. "Install the bracket" is a work element. "Pick two bolts" is not, because it only happens as part of installing the bracket.
What is the difference between value-added work, needed work and waste?
Value-added work changes the product the customer pays for, such as torquing a bolt. Needed work does not change the product, but the job can't be done without it today, such as picking parts or checking a unit. Waste adds nothing and can be removed, such as walking to a rack that is too far away. Keep the value-added work, reduce the needed work and remove the waste.
Is walking a work element?
Write the walk on the sheet with its time, like any element. Mark it as waste, because the goal is to remove it, not to move it to another operator. Move the parts closer and the walk goes away.
How much of a job is value-added work?
Usually less than people expect. In the example in this guide, 12 of the 40 seconds change the product. The other 28 seconds are needed work and waste.
How do you time work elements?
Time each element about ten times with a stopwatch at the job. Use the lowest repeatable time, which is the lowest time that shows up more than once. Do not use the average, because it includes the slow cycles where something went wrong.
